About Us
Oriental Mindoro Electric Cooperative, Inc. (ORMECO, Inc.) is a non-stock, non-profit and service-oriented rural Electric Cooperative, duly organized under existing Philippine laws, rules and regulation.
Our Vision
A dynamic and competitive Electric Cooperative in service delivery for member-consumers satisfaction with utilization of renewable energy.
Announcement

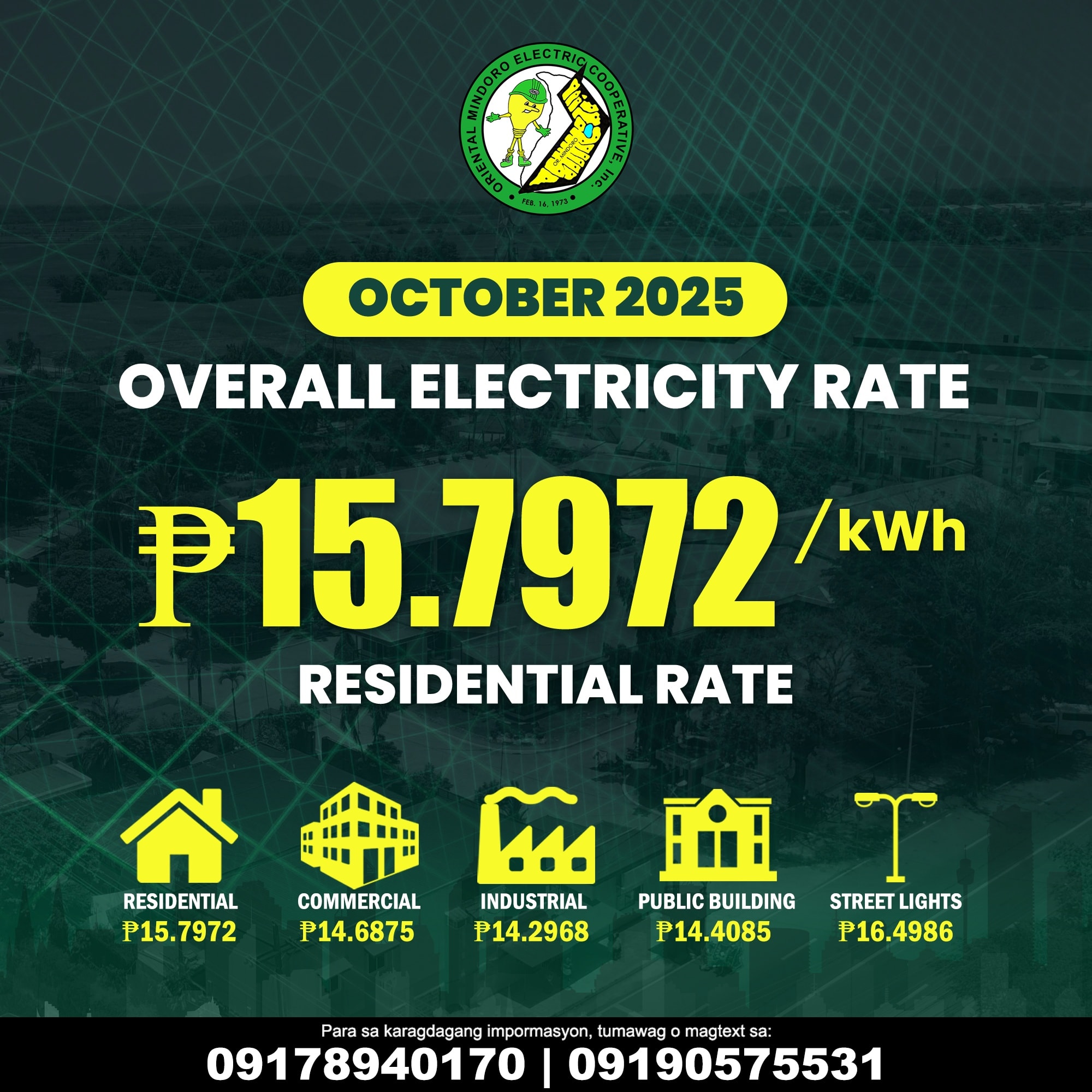

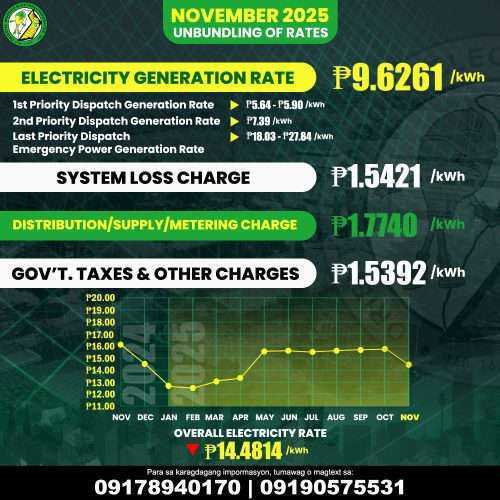

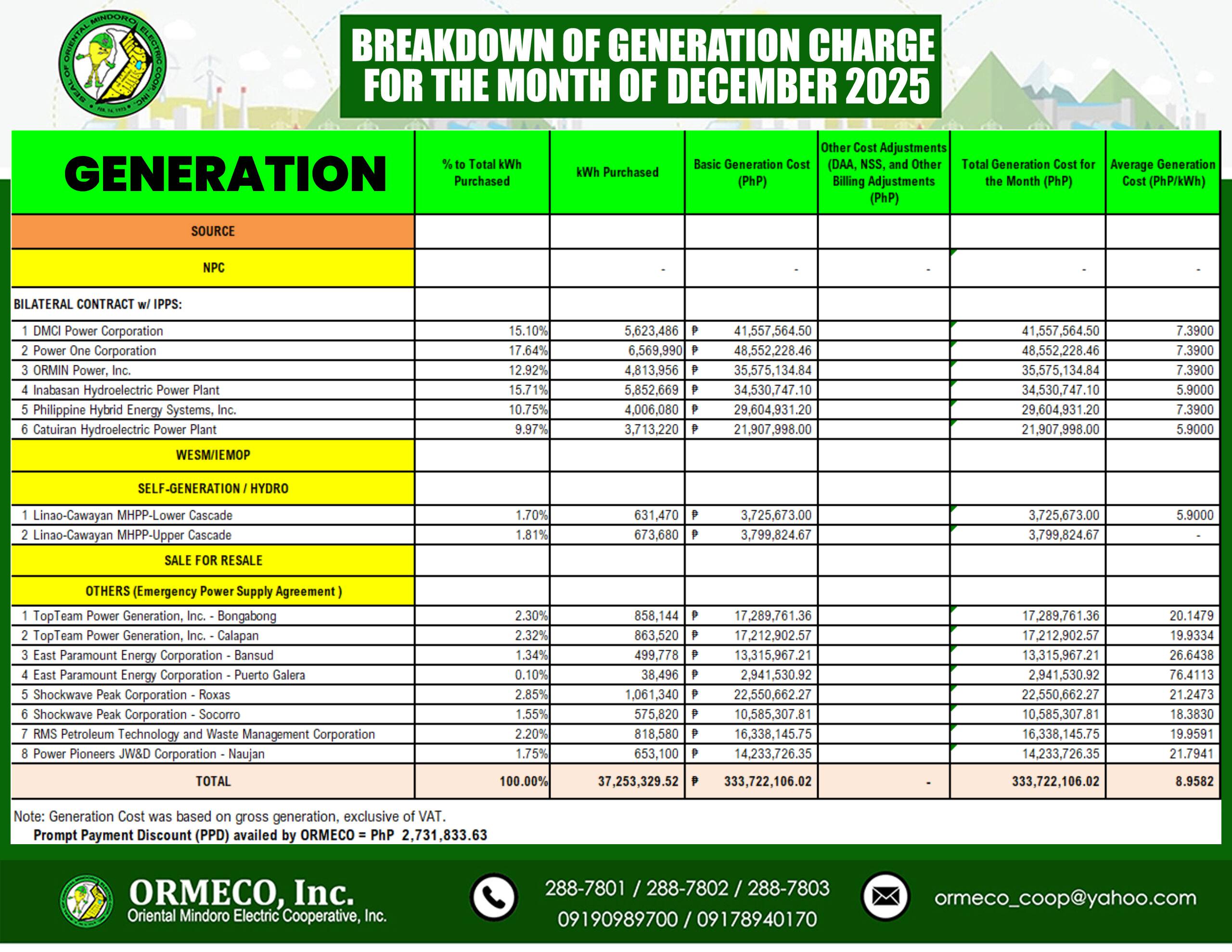

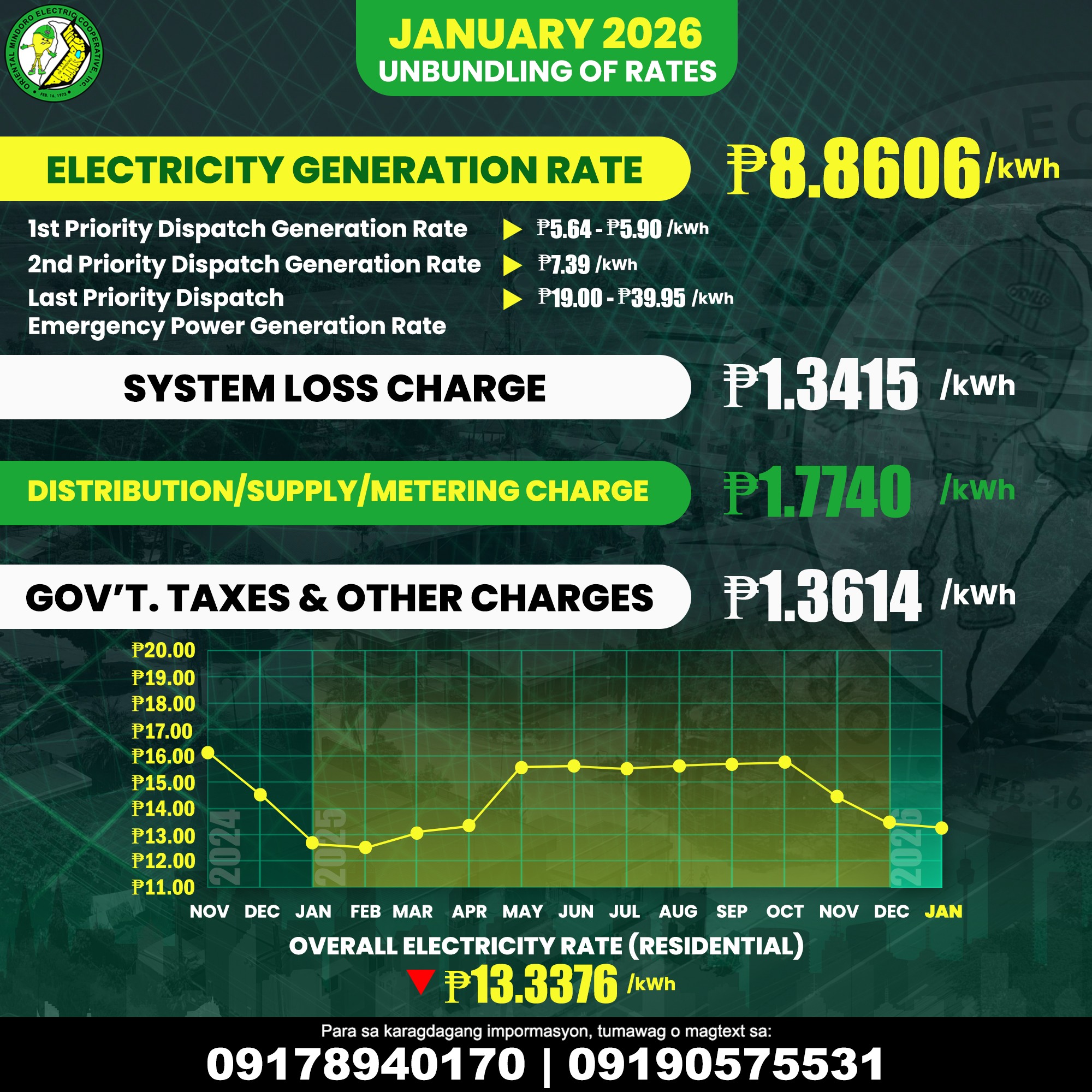

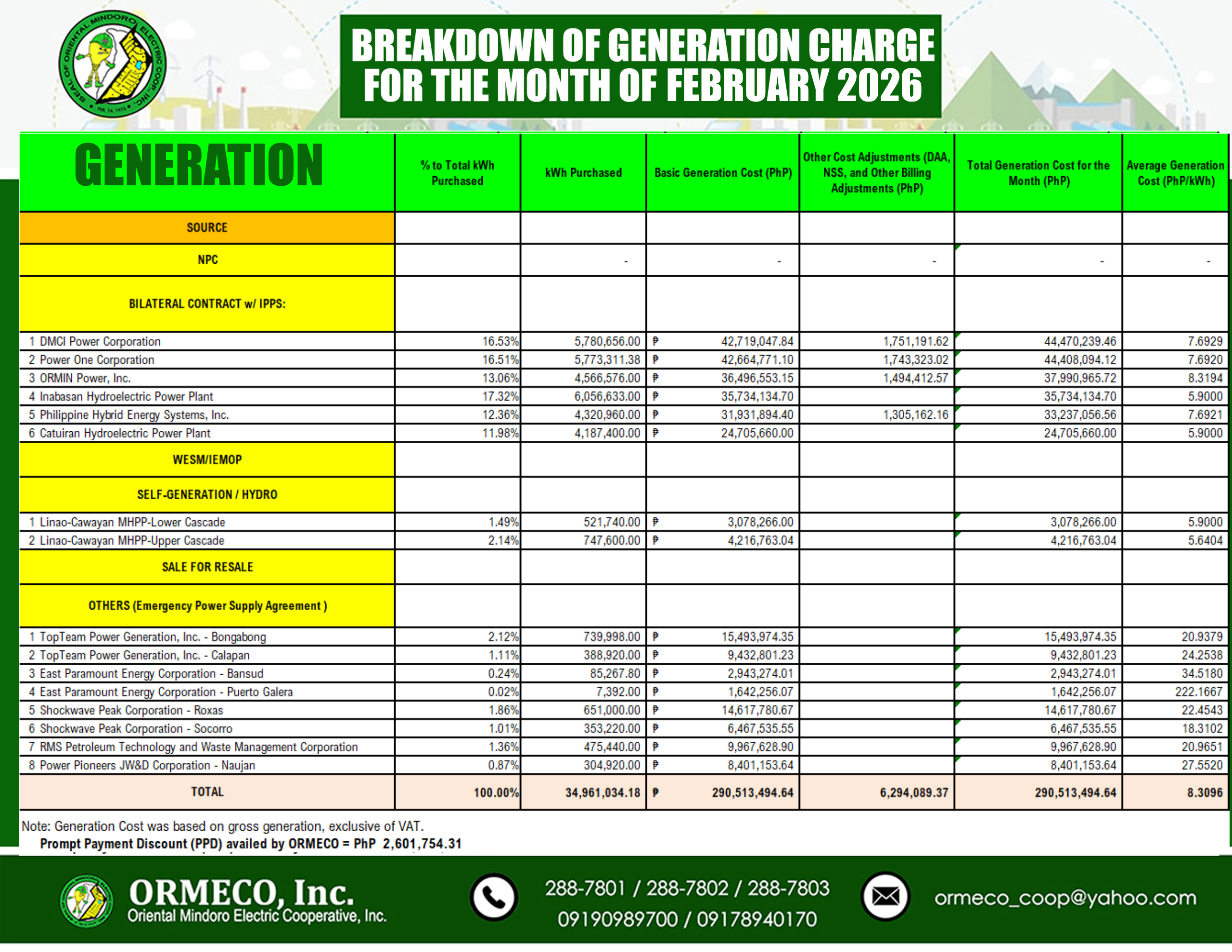

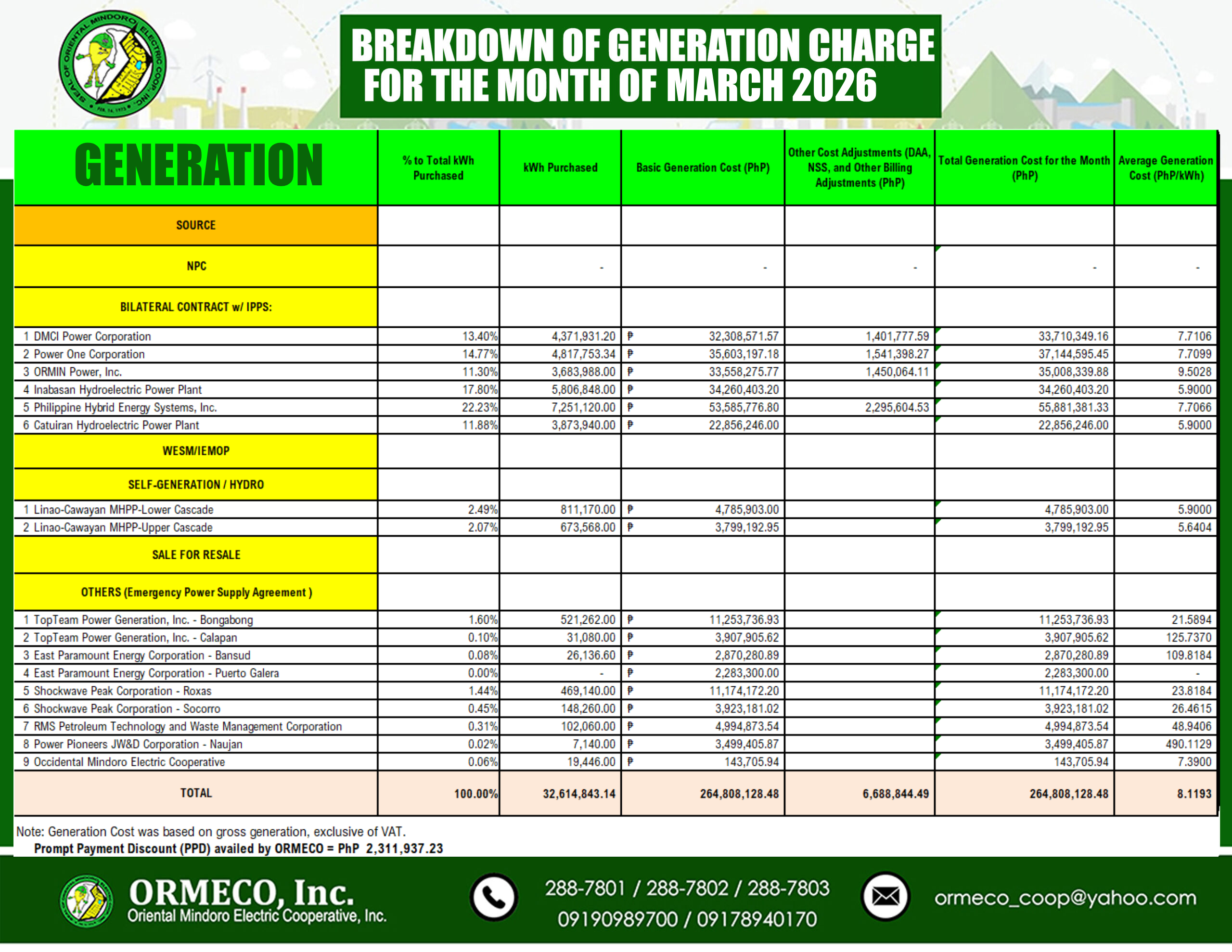

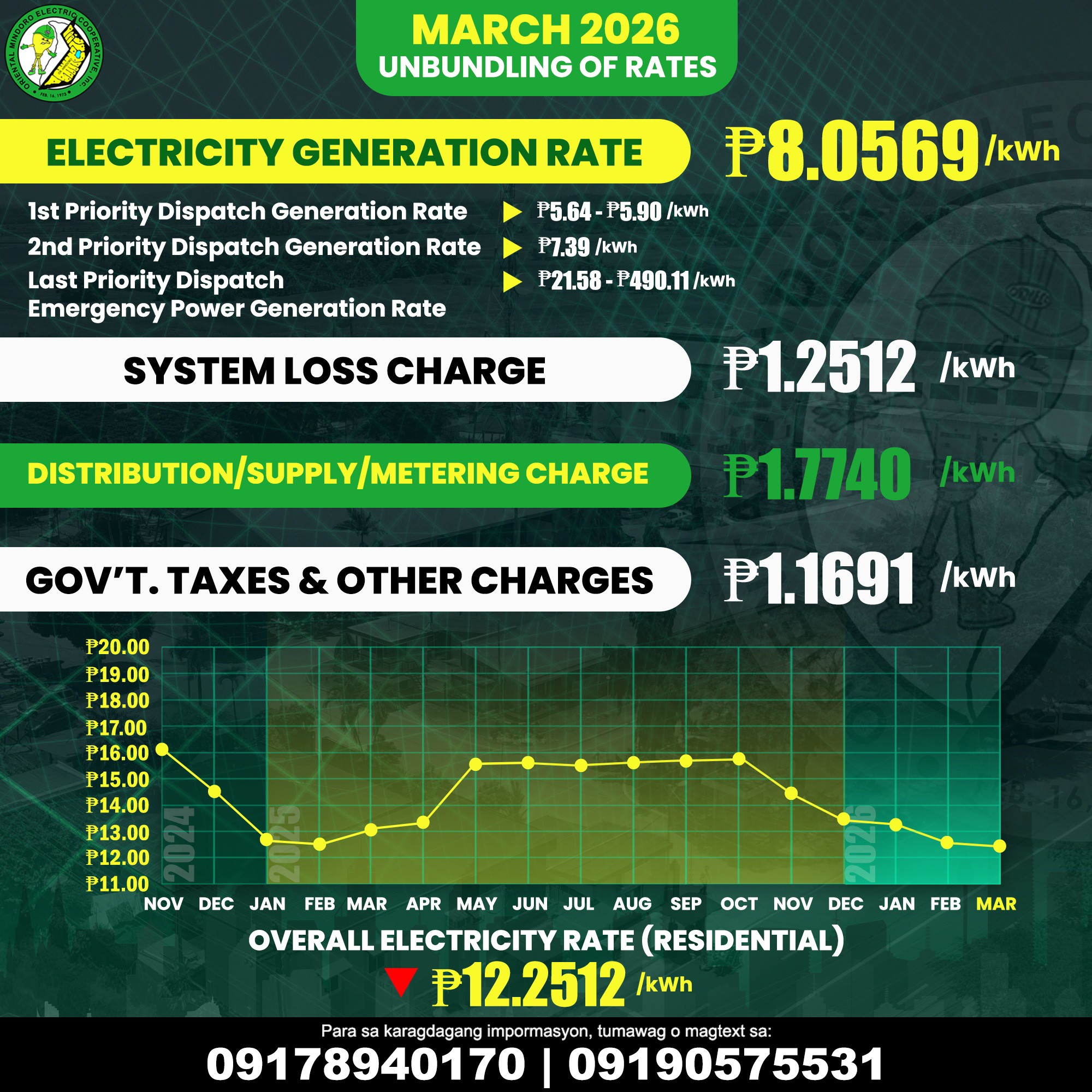

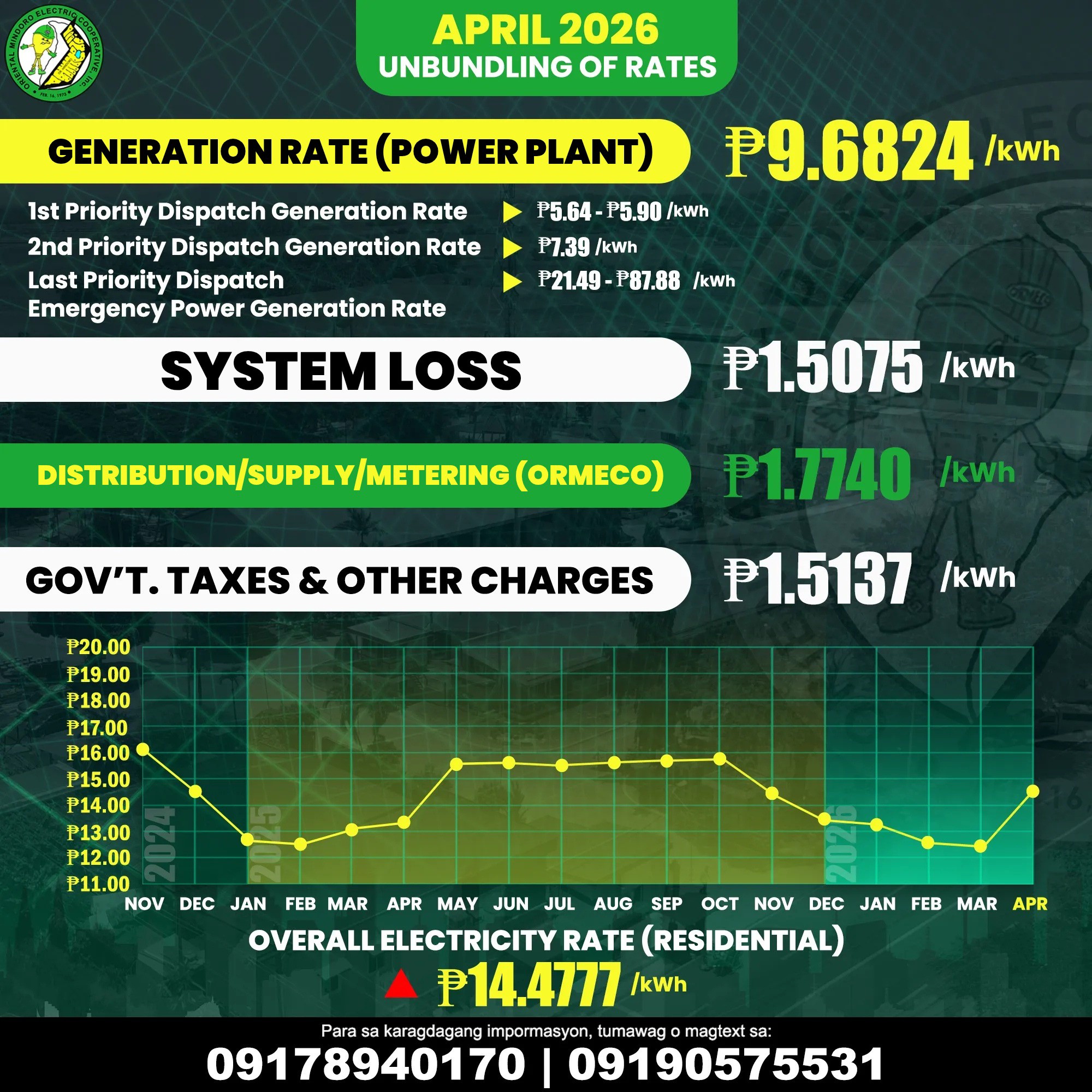

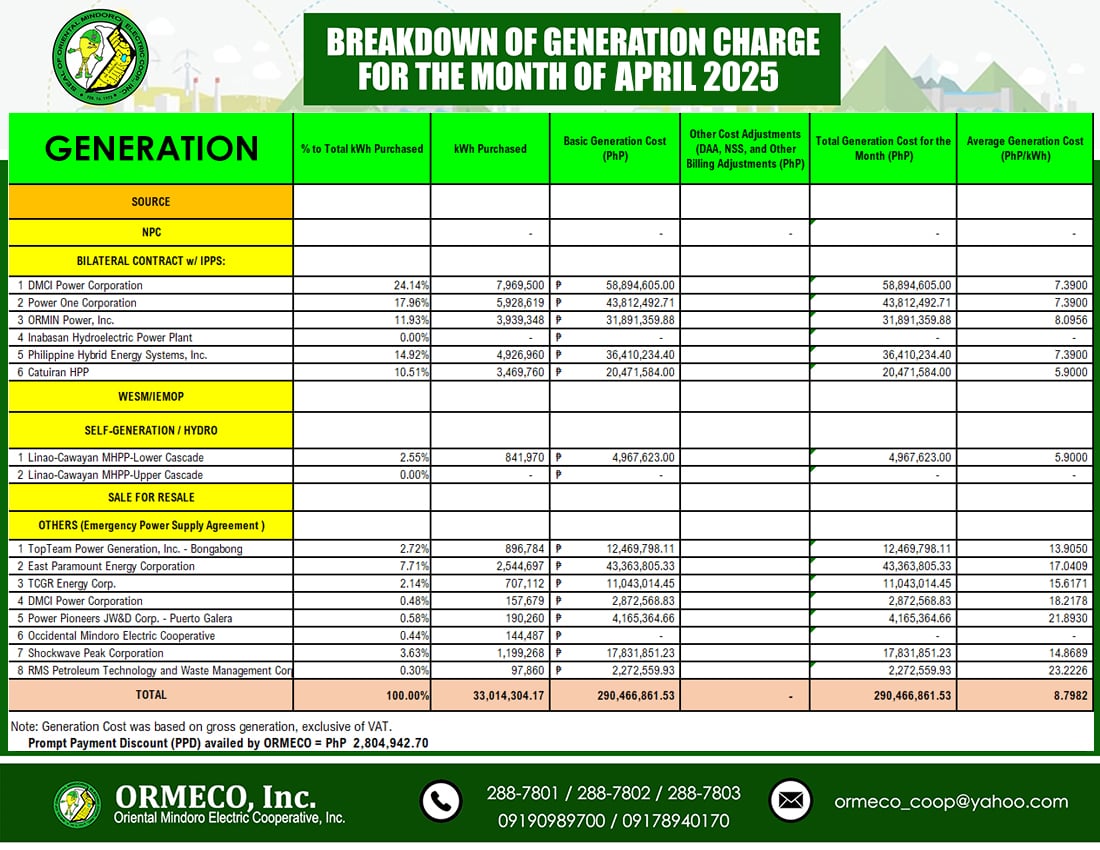

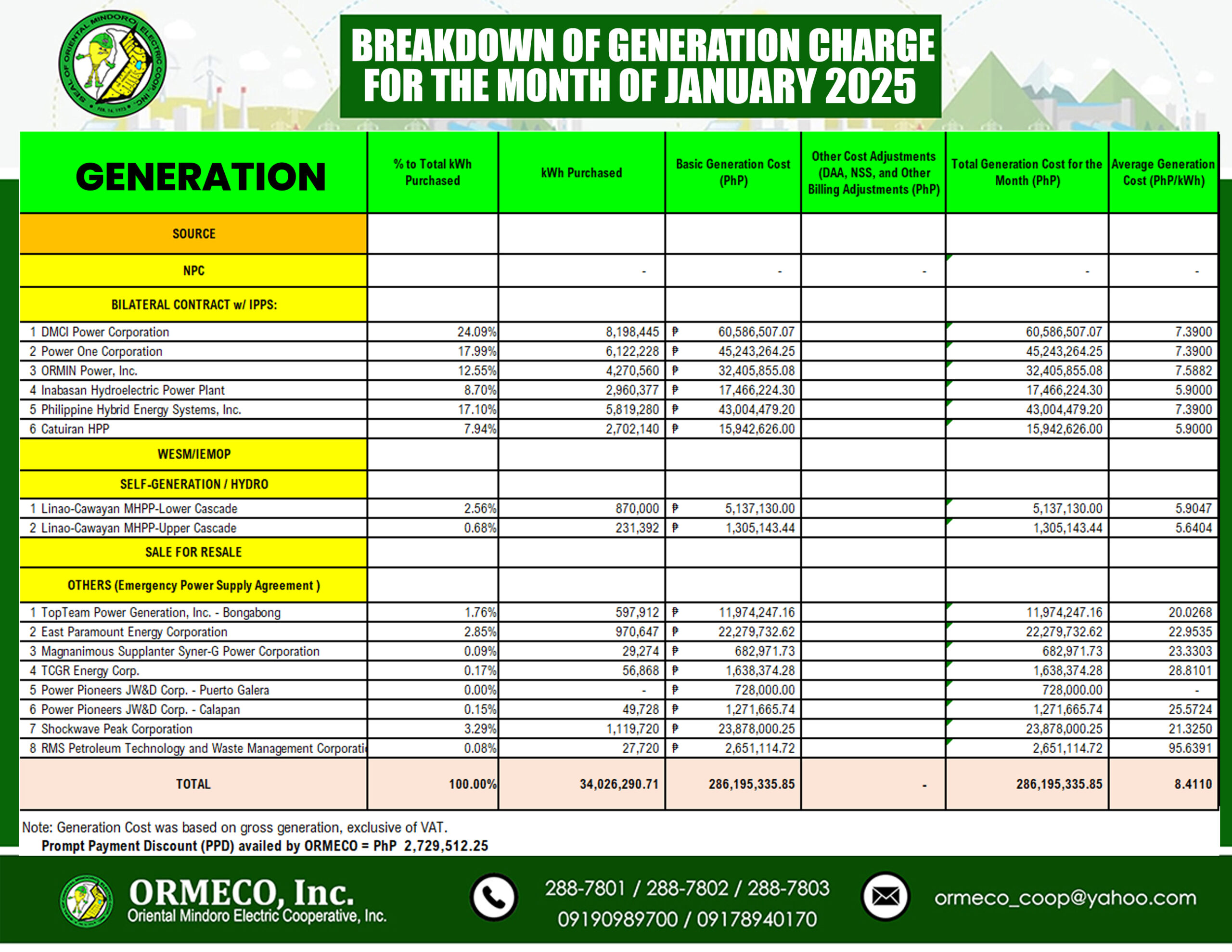

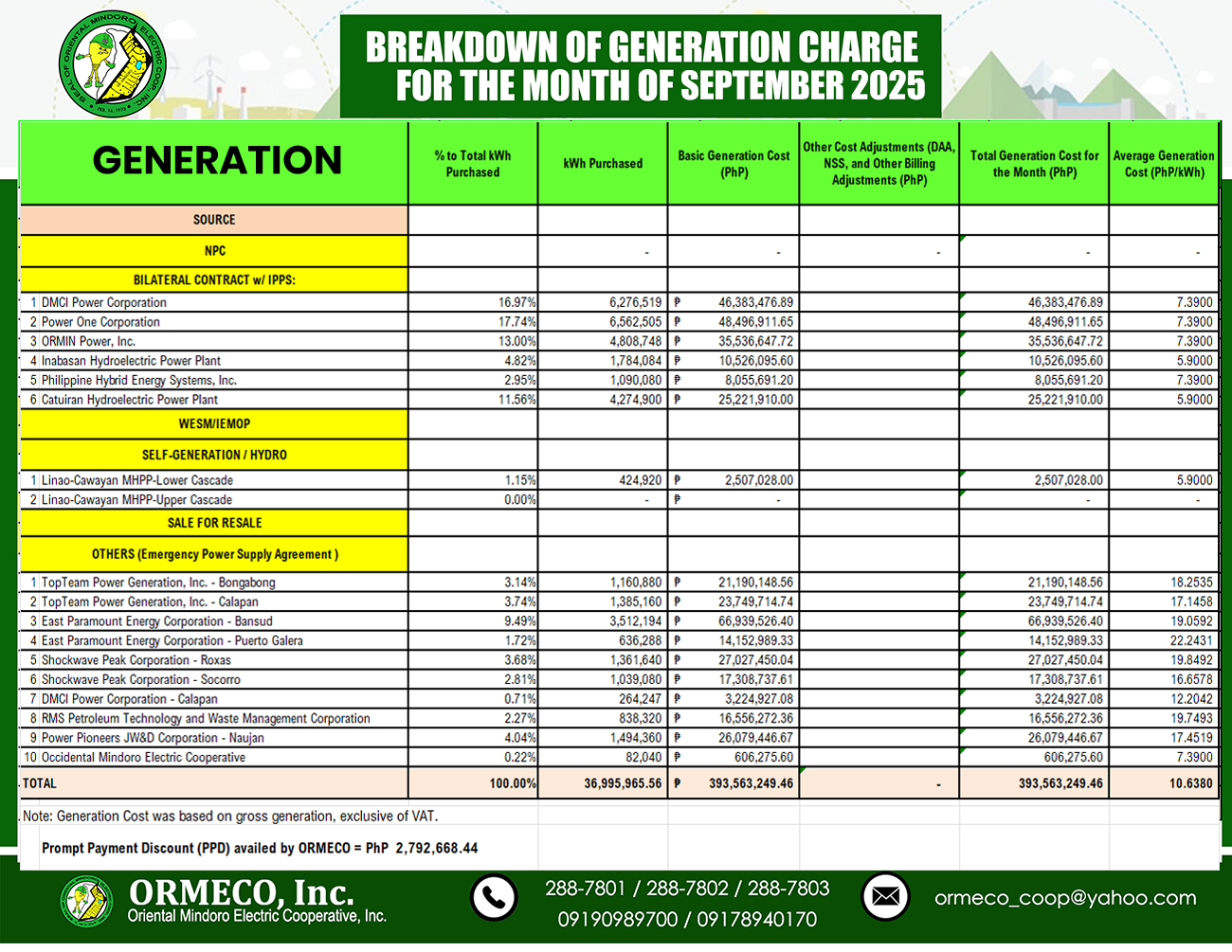

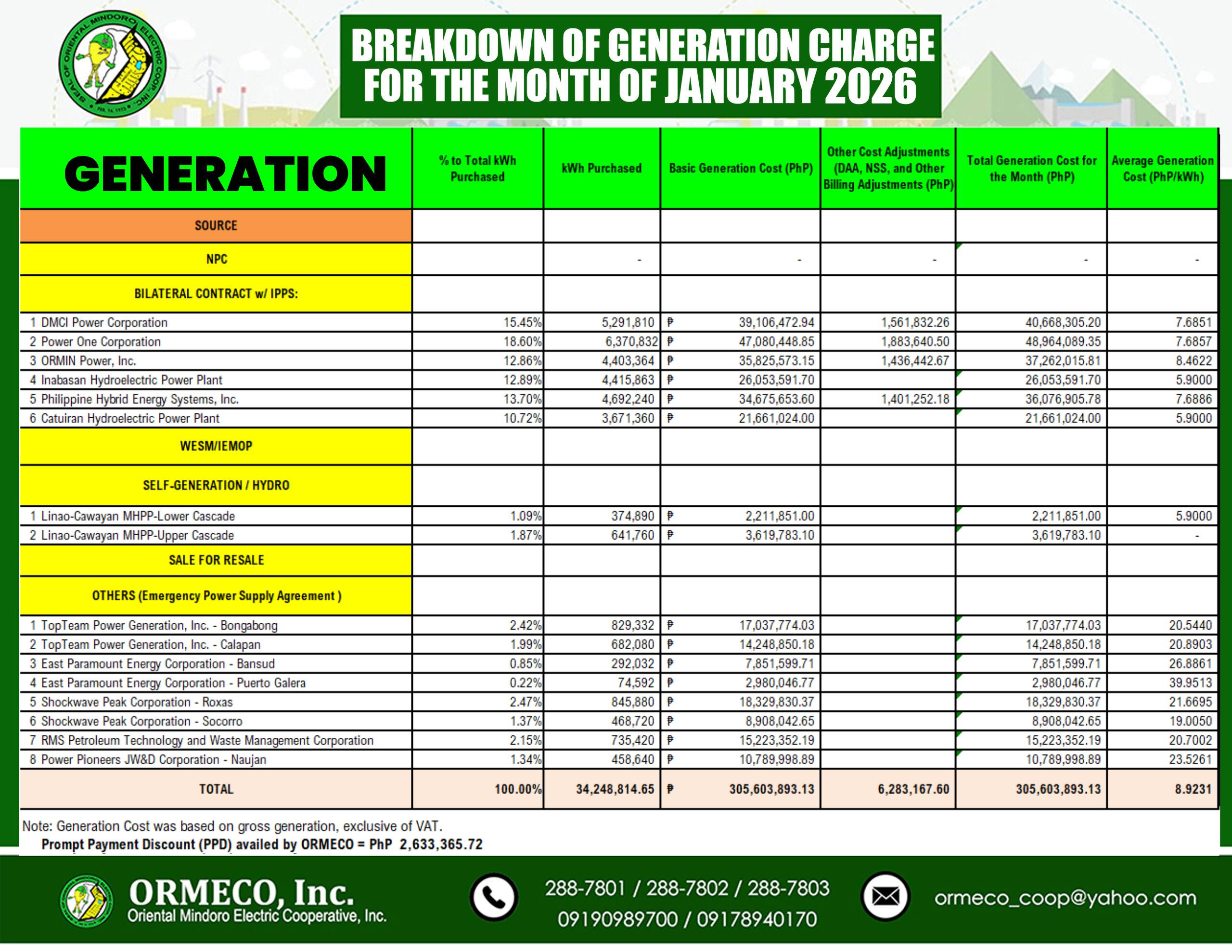

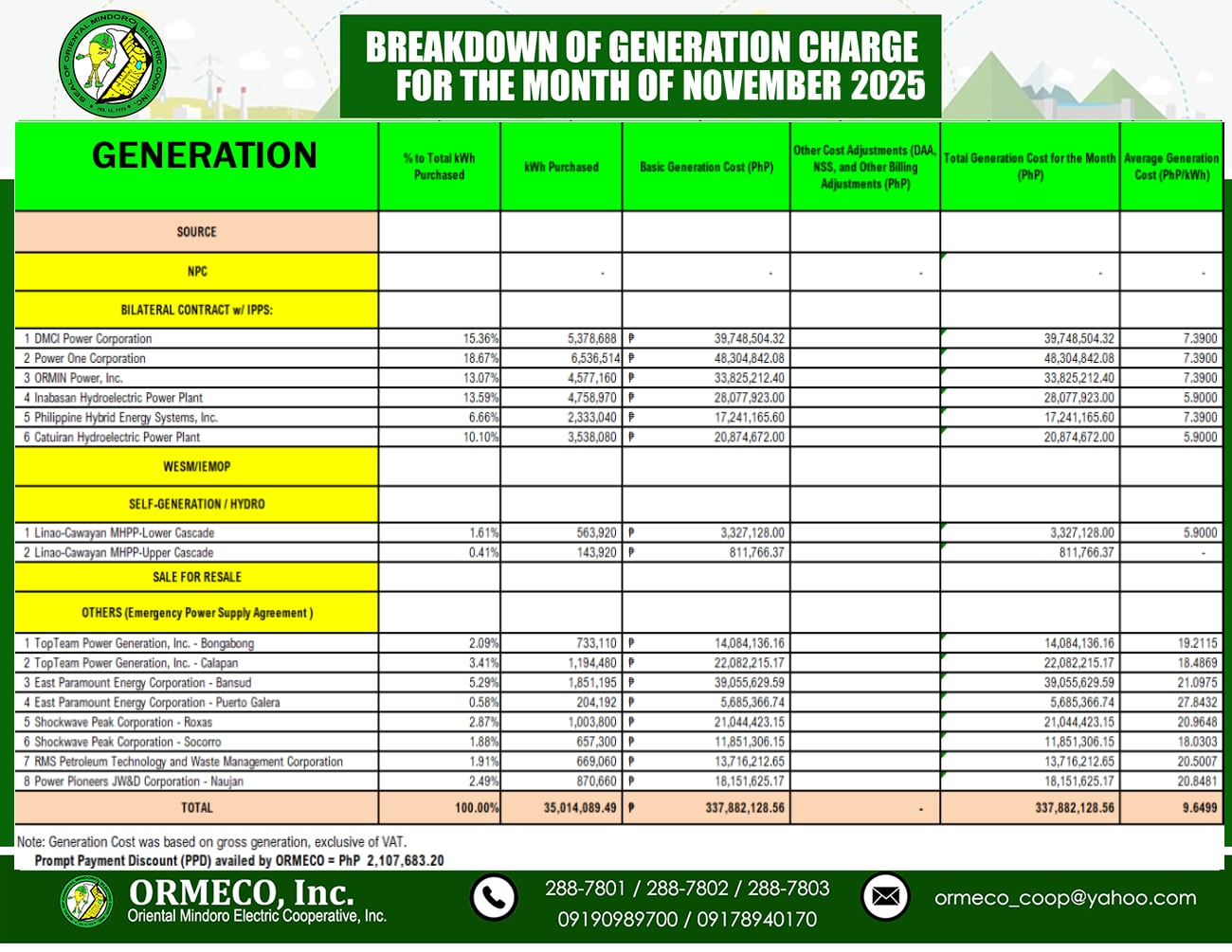

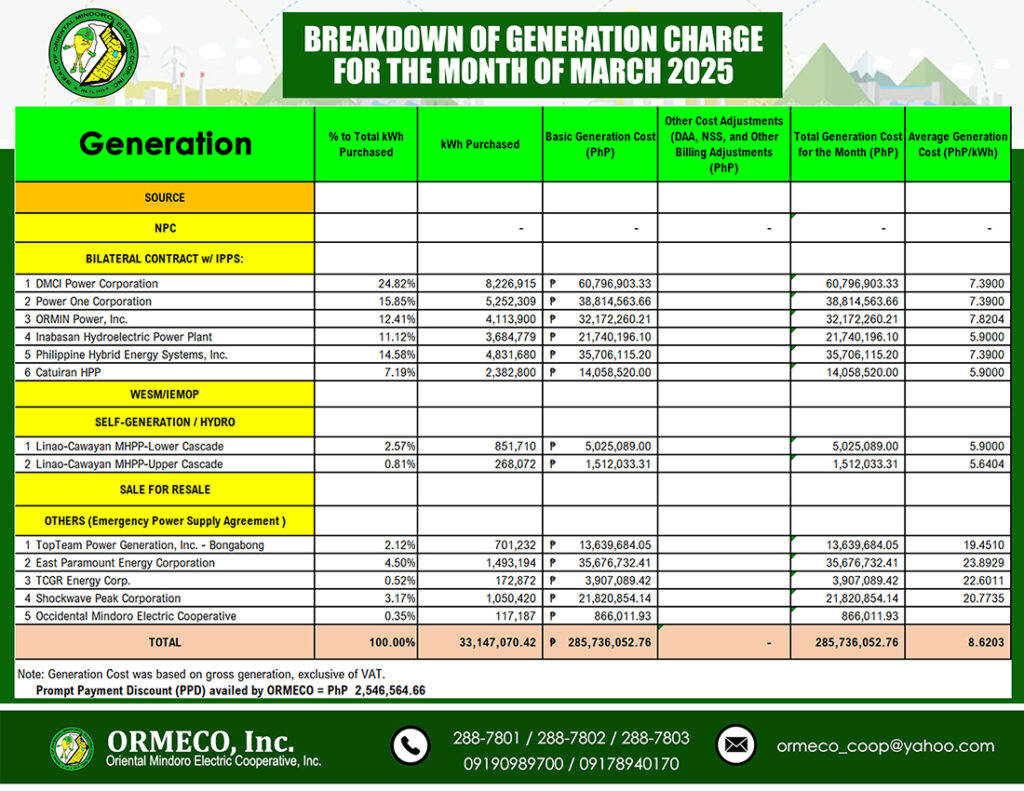

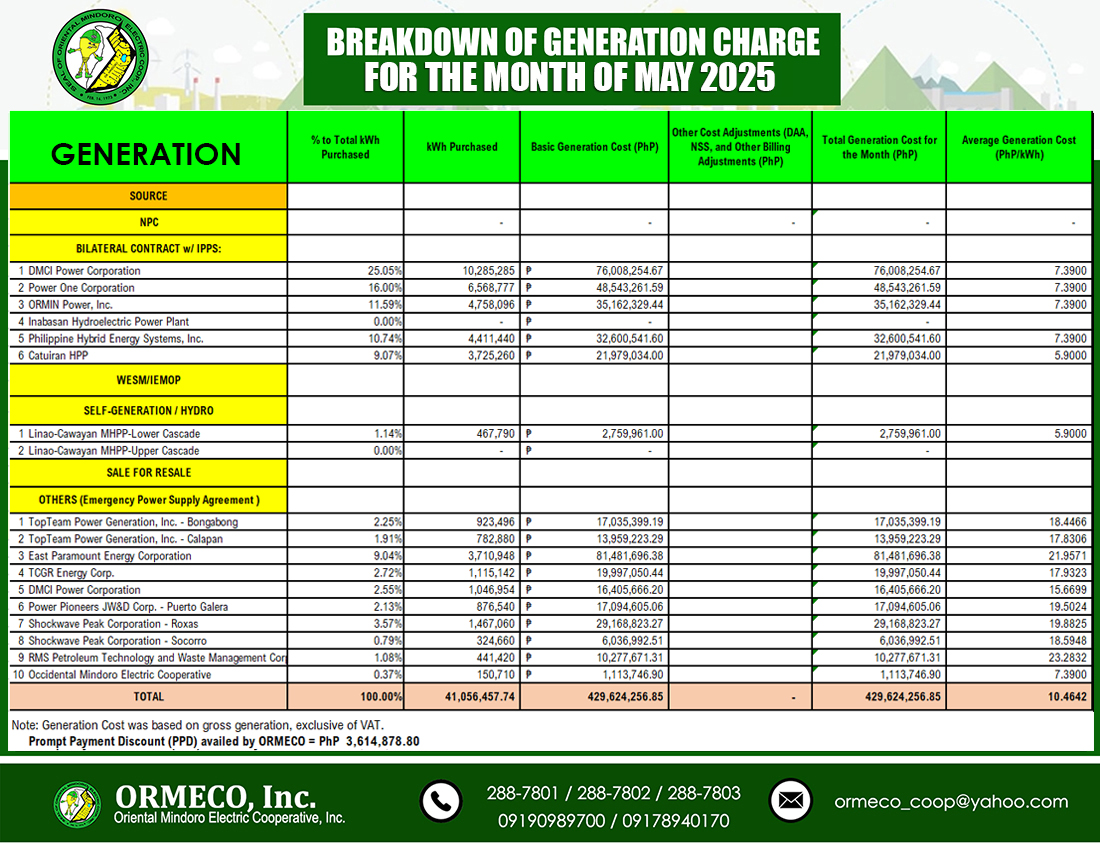

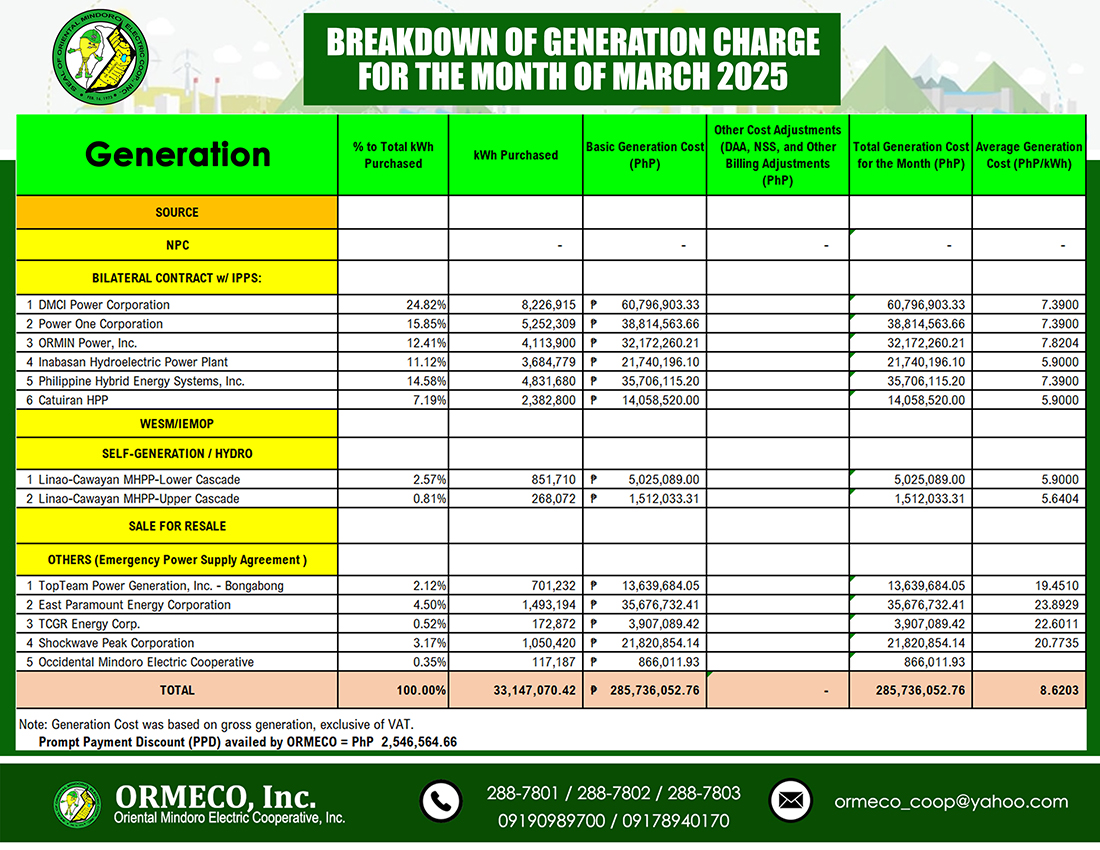

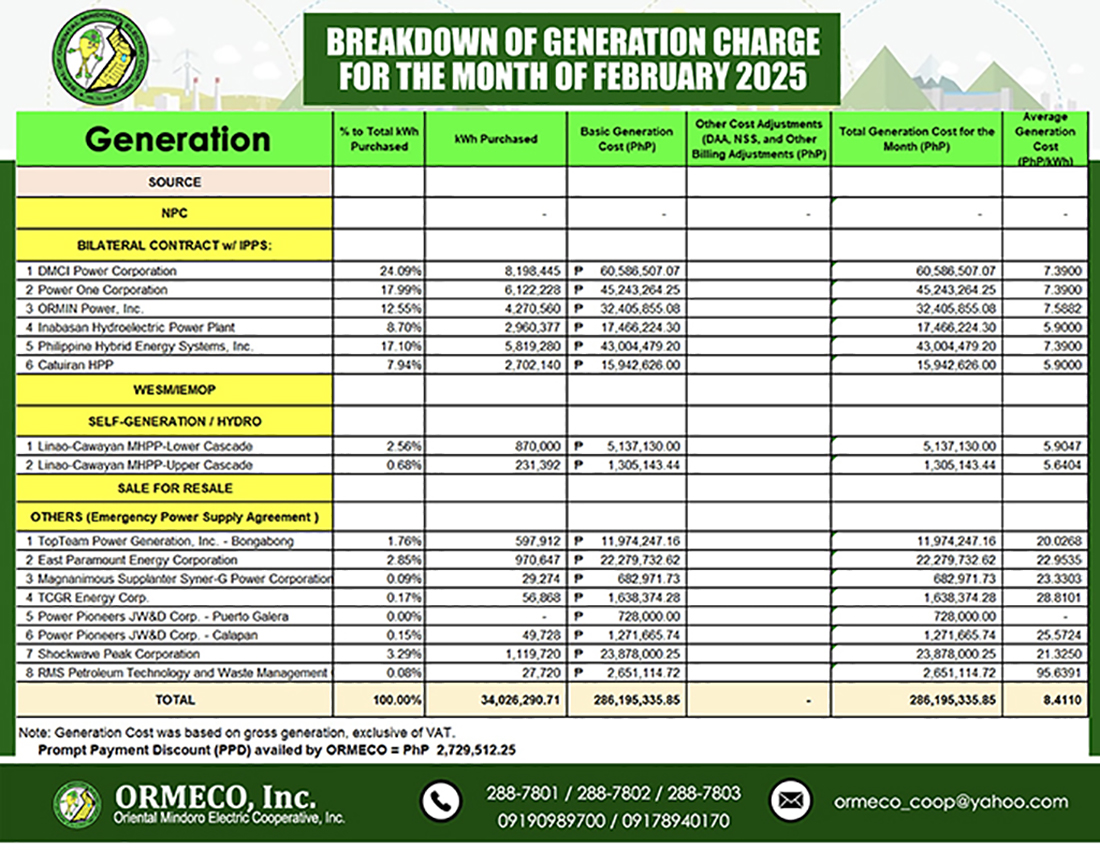

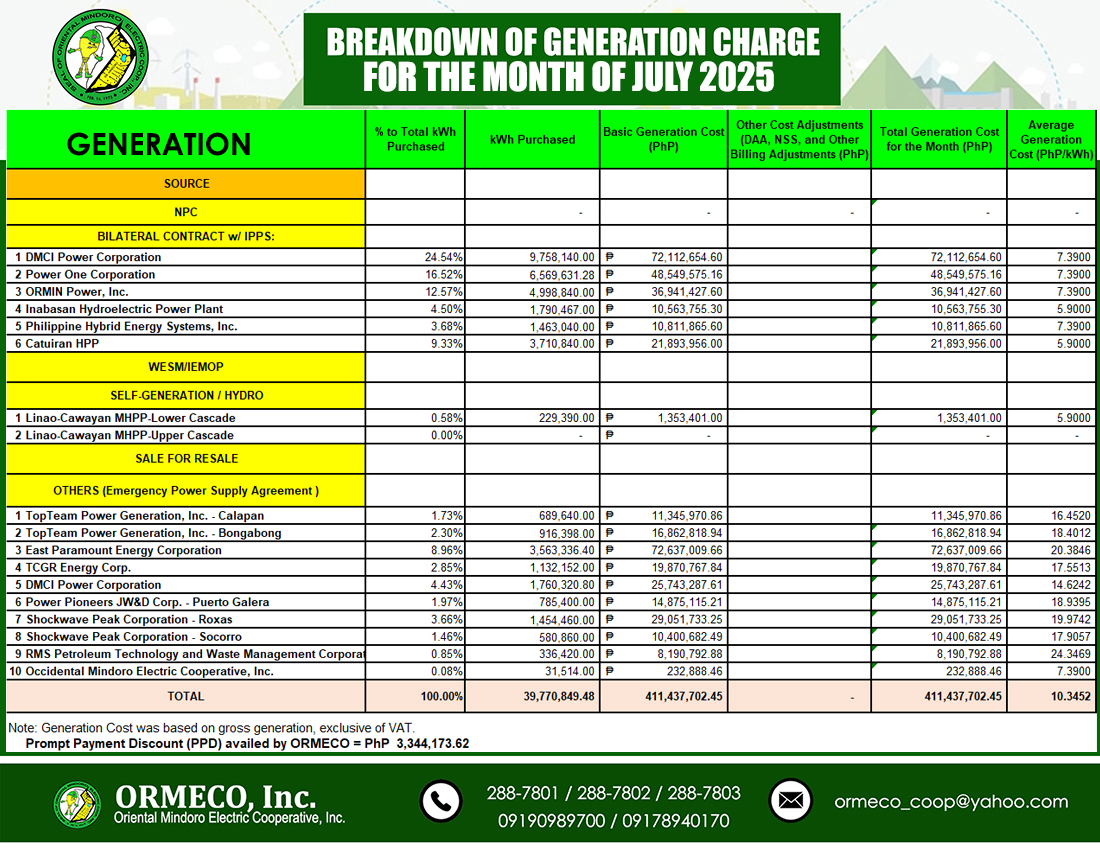

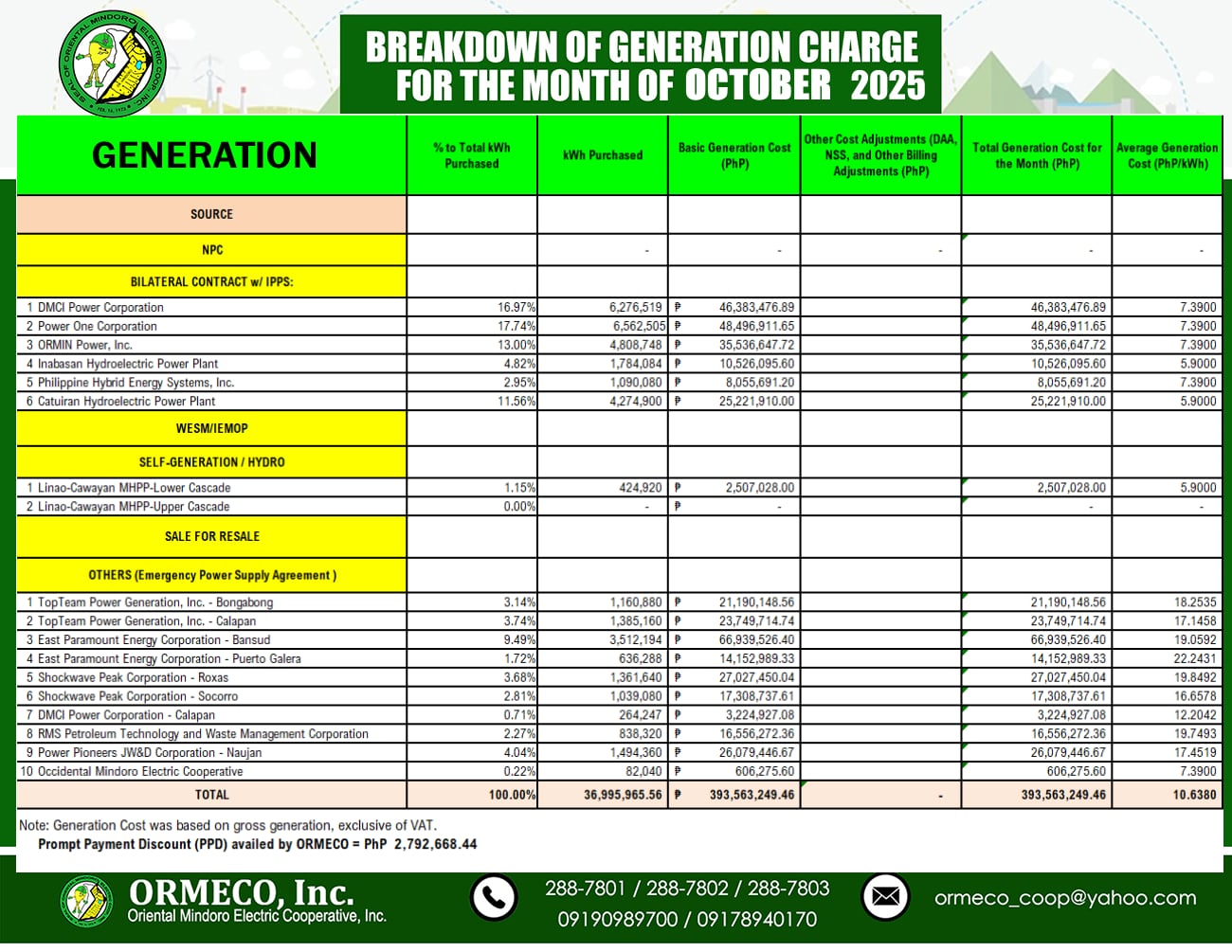

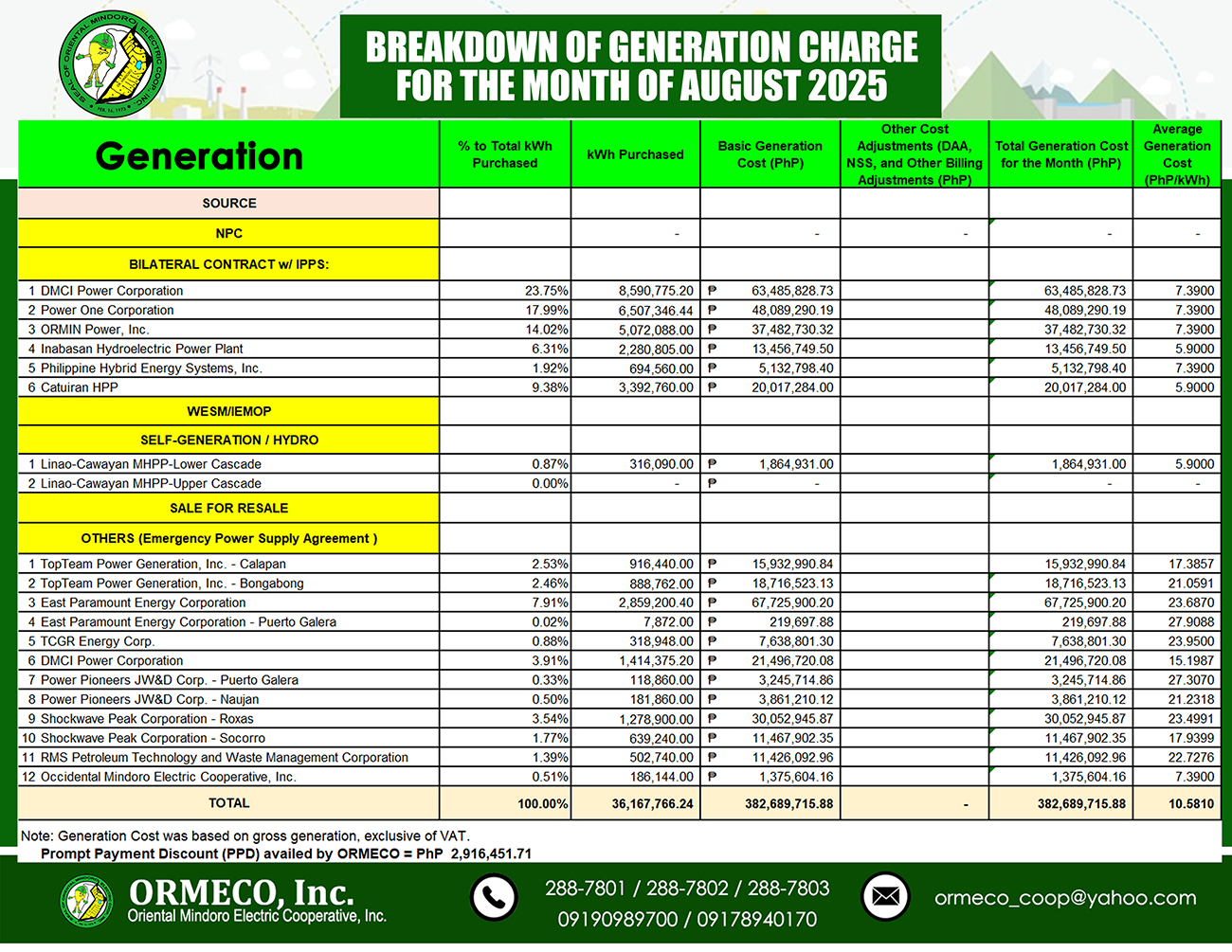

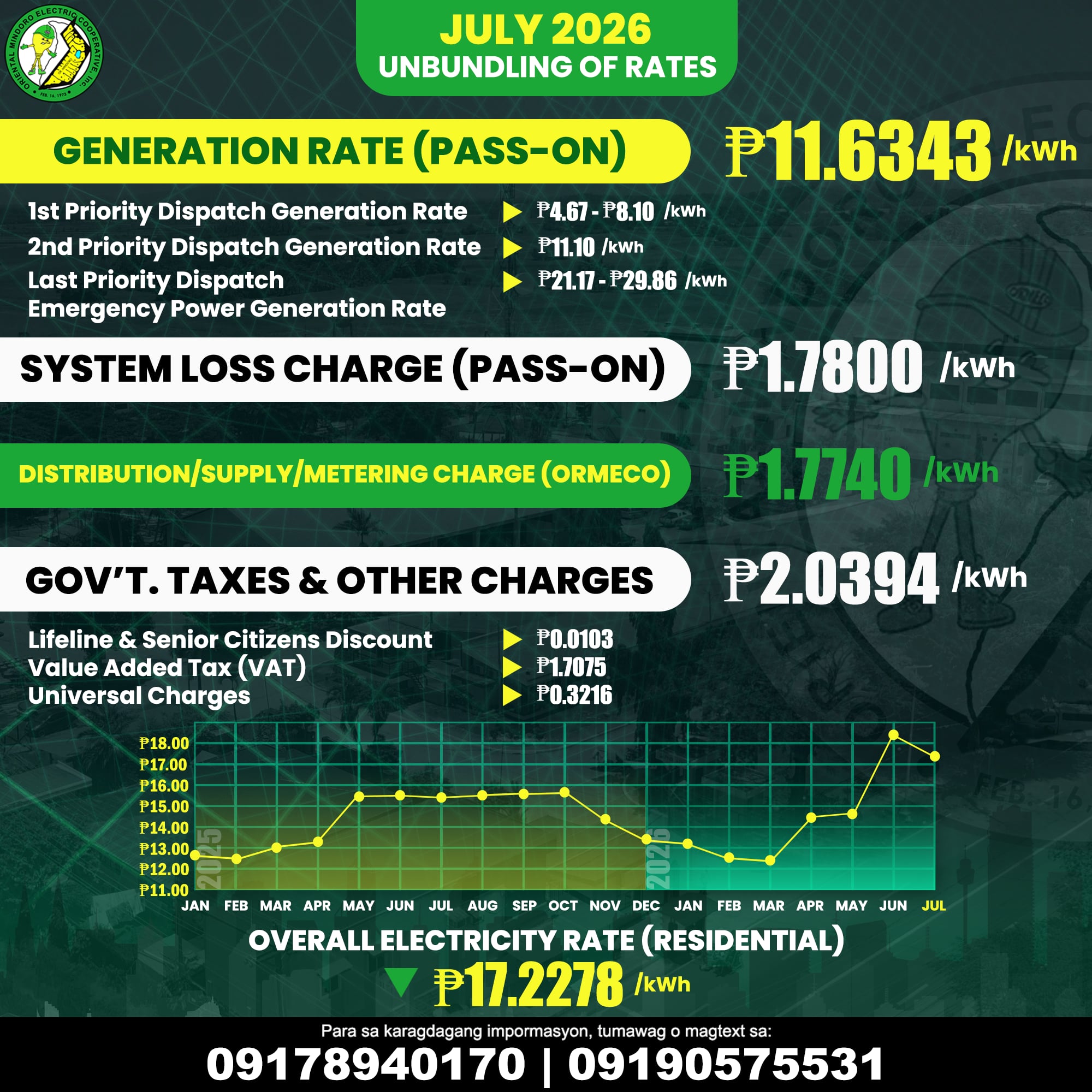

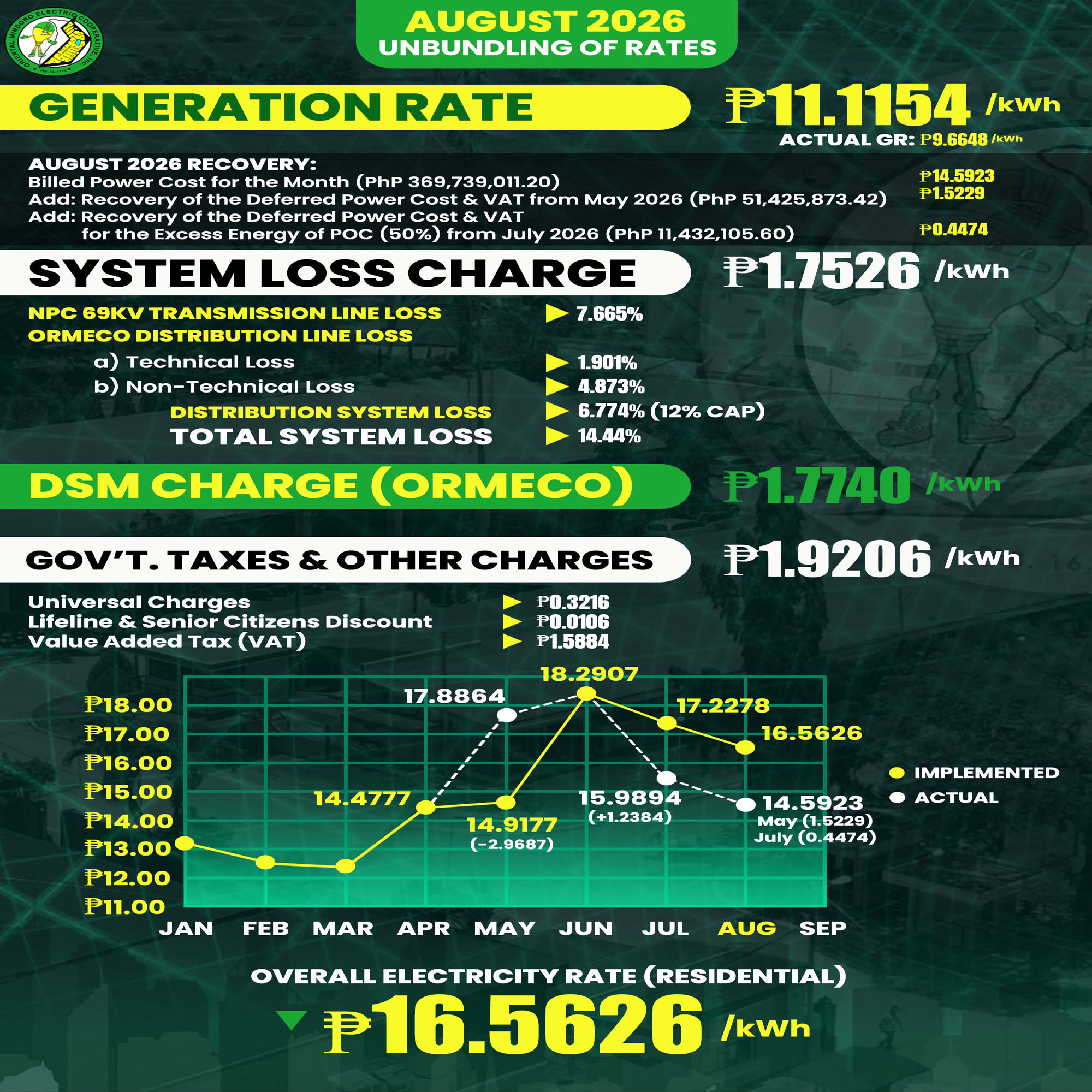

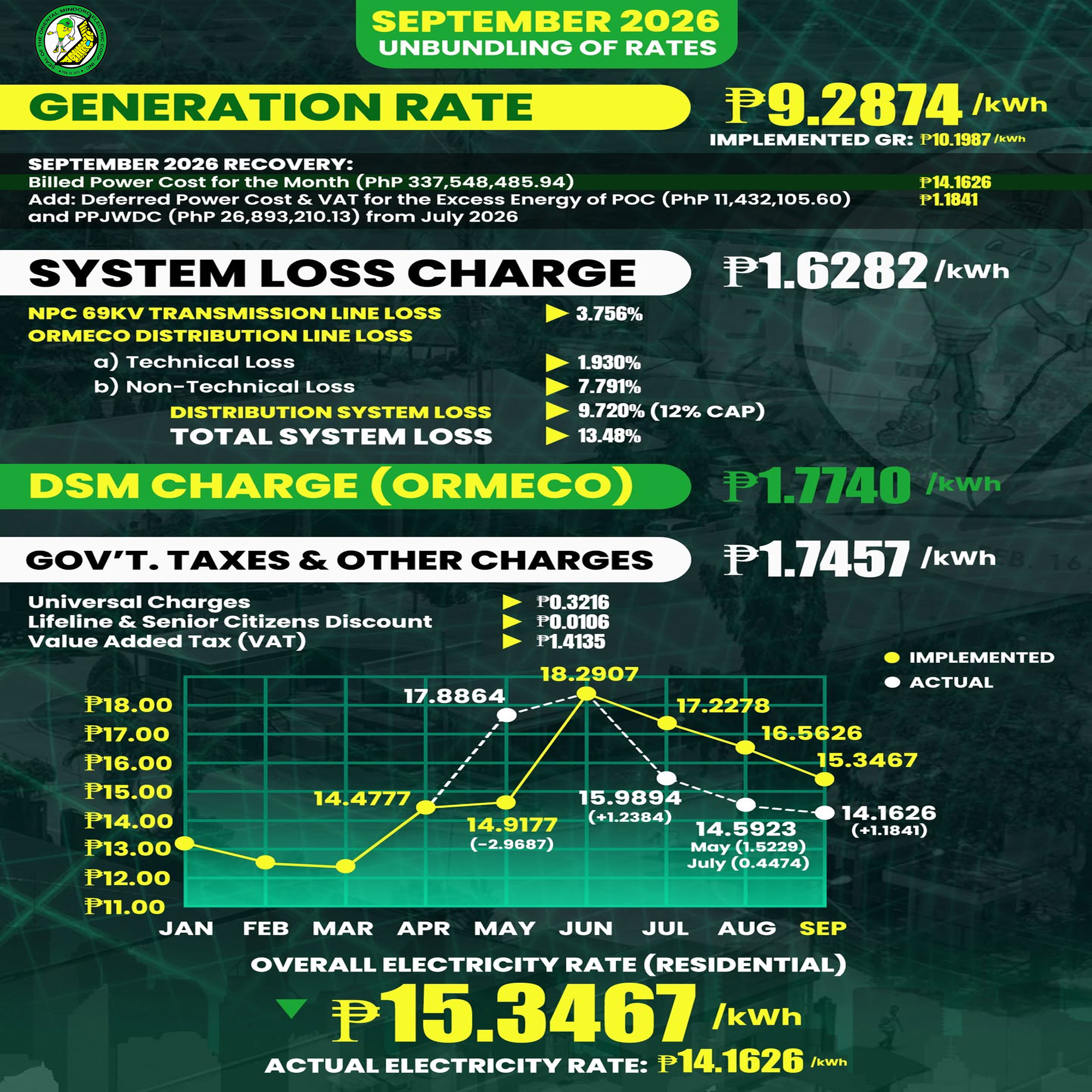

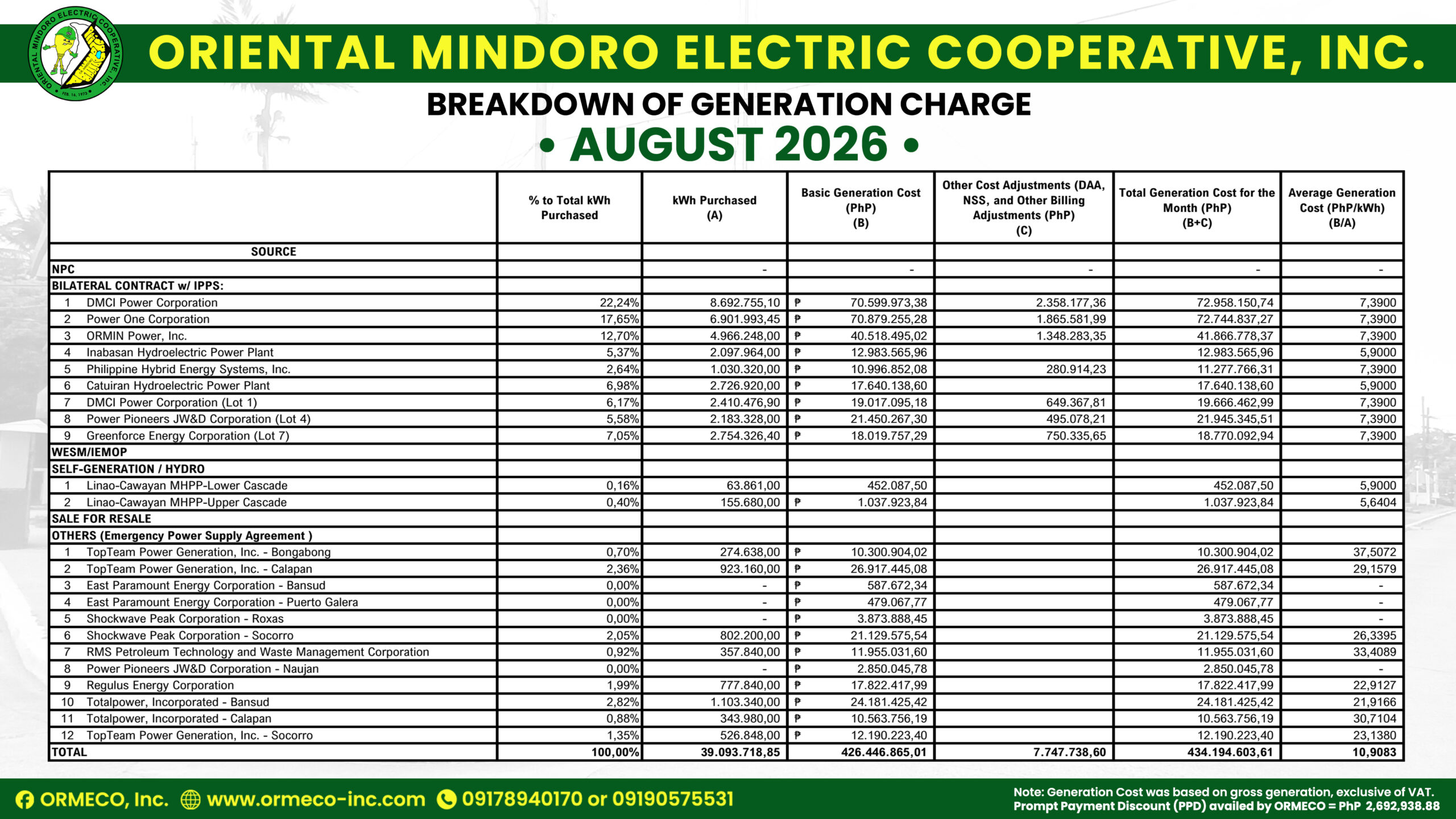

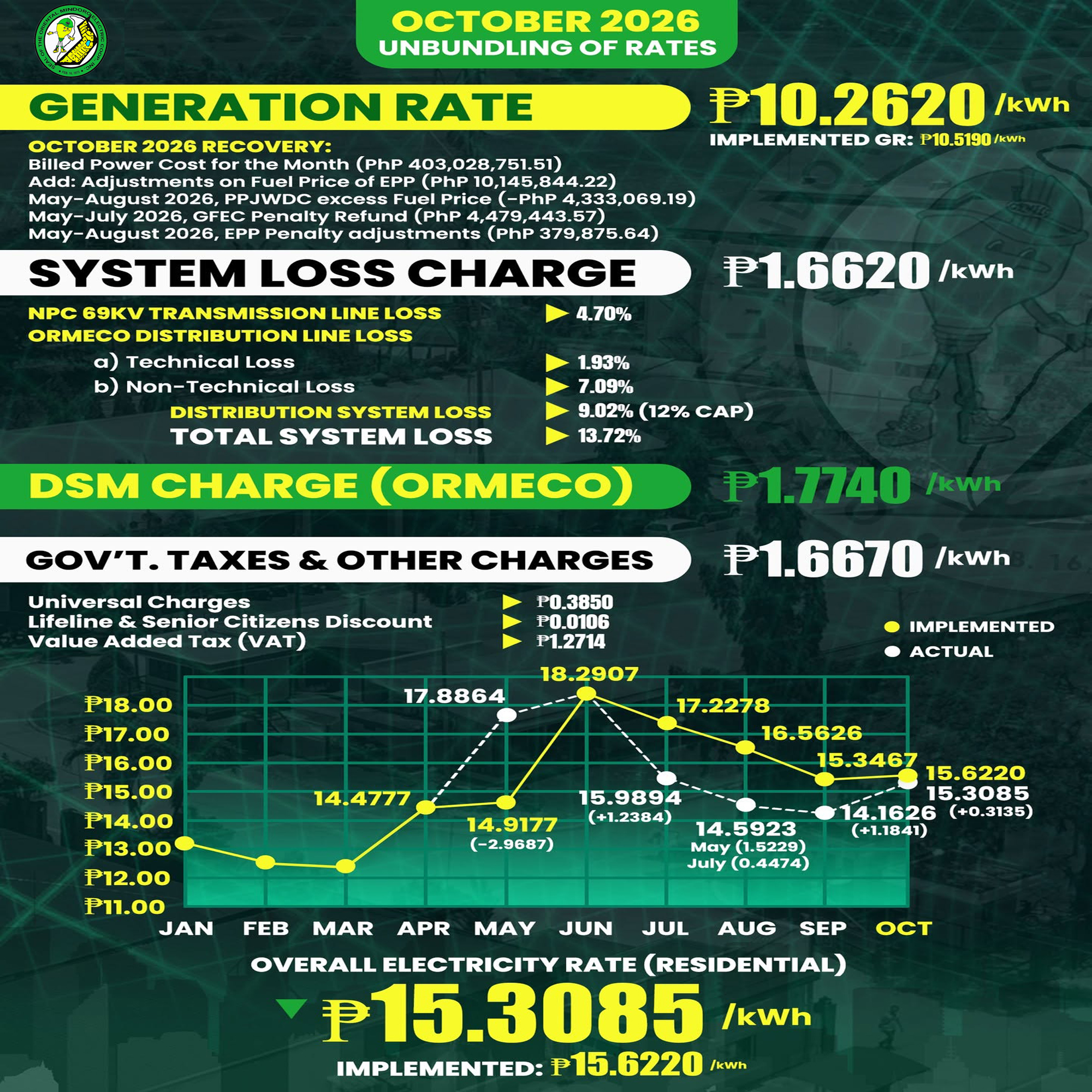

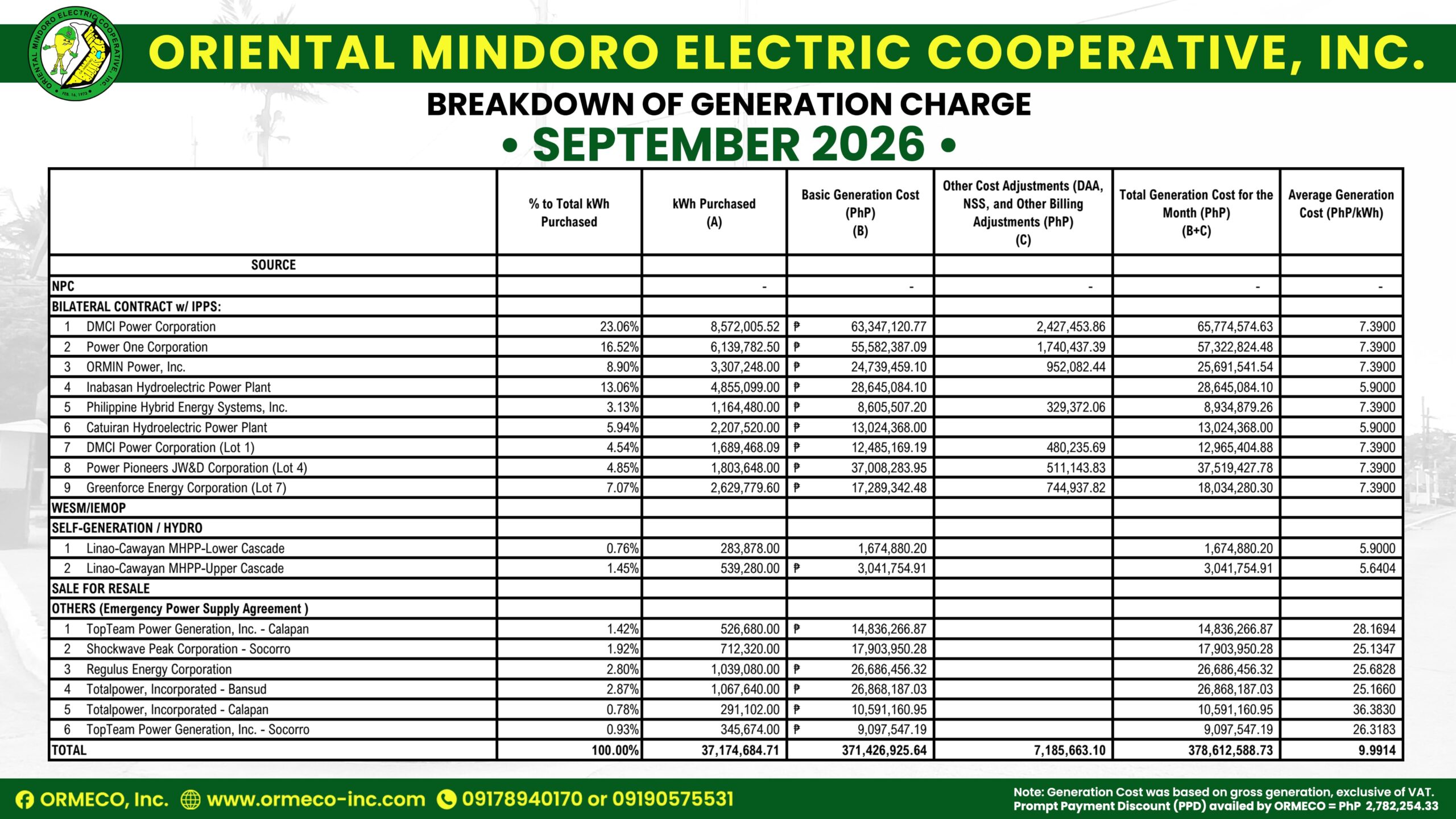

Breakdown of Generation Charge
News and Events
Muling ipinamalas ng mga mag-aaral mula sa 𝐌𝐢𝐧𝐝𝐨𝐫𝐨 𝐒𝐭𝐚𝐭𝐞 𝐔𝐧𝐢𝐯𝐞𝐫𝐬𝐢𝐭𝐲 (𝐌𝐢𝐧𝐬𝐔), 𝐂𝐚𝐥𝐚𝐩𝐚𝐧 𝐂𝐚𝐦𝐩𝐮𝐬 ang kanilang husay sa larangan ng teknolohiya sa pamamagitan ng isang makabagong 𝐜𝐚𝐩𝐬𝐭𝐨𝐧𝐞 𝐩𝐫𝐨𝐣𝐞𝐜𝐭 na naglalayong makatulong sa pagpapahusay ng serbisyo ng 𝐎𝐫𝐢𝐞𝐧𝐭𝐚𝐥 𝐌𝐢𝐧𝐝𝐨𝐫𝐨 𝐄𝐥𝐞𝐜𝐭𝐫𝐢𝐜 𝐂𝐨𝐨𝐩𝐞𝐫𝐚𝐭𝐢𝐯𝐞, 𝐈𝐧𝐜. (𝐎𝐑𝐌𝐄𝐂𝐎, 𝐈𝐧𝐜.).
Nakiisa ang Oriental Mindoro Electric Cooperative, Inc. (ORMECO) sa joint cable bundling operation na inilunsad ng City Engineering and Public Works Department ng Calapan City, kasama ang City Environment and Natural Resources Department, Public Safety Department, at ang Office of the City Mayor noong ika-23 ng Abril 2026.
Pinalawak na ng ORMECO ang opisina nito sa bayan ng Naujan sa pamamagitan ng planong maglagay ng bagong sub-office sa Barangay Evangelista bilang bahagi ng patuloy na pagsisikap na mapalapit ang serbisyo sa mga Member-Consumer-Owners (MCO’s).Facebook Feed
‼️EMERGENCY INTERRUPTION‼️ 🗓️JUNE 18, 2026 | THURSDAY | 7:00 AM - 12:00 NN ⚡️PURPOSE: CORRECTION AND CLEARING OF LINES REPLACEMENT OF ROTTEN POLES 📌AFFECTED AREA/S: 📍PUERTO GALERA : FEEDER PG100 PORTION OF BRGYS. SAN ISIDRO, BRGYS, BALATERO, STO. NIÑO, POBLACION, SABANG, PALANGAN, SAN ANTONIO, BRGYS. TABINAY, DULANGAN AND PORTION OF BRGYS. VILLAFLOR Power Service may be restored earlier or upon completion of work/s cited above. Thank you! 💡
⚡ 𝐎𝐑𝐌𝐄𝐂𝐎 𝐒𝐓𝐀𝐍𝐃𝐈𝐍𝐆 𝐅𝐈𝐑𝐌 𝐎𝐍 𝐒𝐀𝐅𝐄𝐓𝐘 𝐀𝐍𝐃 𝐂𝐎𝐌𝐏𝐋𝐈𝐀𝐍𝐂𝐄 ⚡ ORMECO General Manager Engr. Humphrey Dolor recently convened a crucial Joint-Pole-Agreement (JPA) Meeting with ORMECO District Chiefs and Area Services Department (ASD) Managers. The meeting was called to directly address pressing reports and challenges regarding telecommunication wires and their impact on ORMECO's poles. Key Highlights: 💡 Safety First: GM Dolor provided updates on the hazards of solar streetlights situated too close to power lines. 🚫 Strict Restrictions: ORMECO is actively installing new poles, but GM Dolor firmly stated that the JPA will not be allowed to attach telco wires to these new structures. 🪵 Independent Infrastructure: The GM strongly encouraged telecom companies to install their own poles moving forward. 💰 Financial Accountability: The status of pending collectibles from the JPA was also thoroughly discussed. GM Dolor stated, reinforcing ORMECO's zero-tolerance policy for non-compliance: "We have to be consistent, if it's prohibited, then it's prohibited." "What we need here is commitment." Moving forward, GM Dolor has strictly instructed the JPA to remain fully compliant with all regulations to ensure the safety and reliability of our electric service.

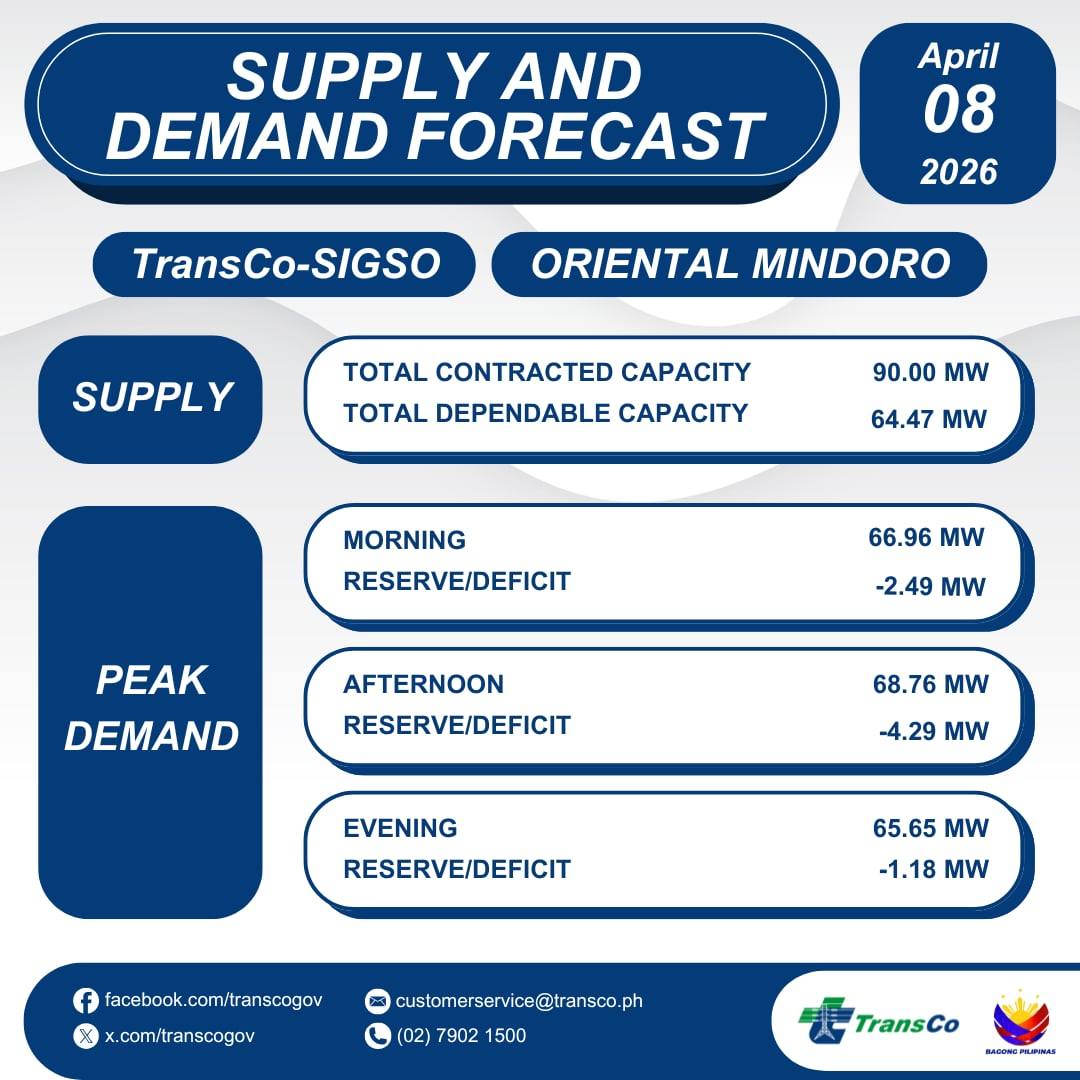

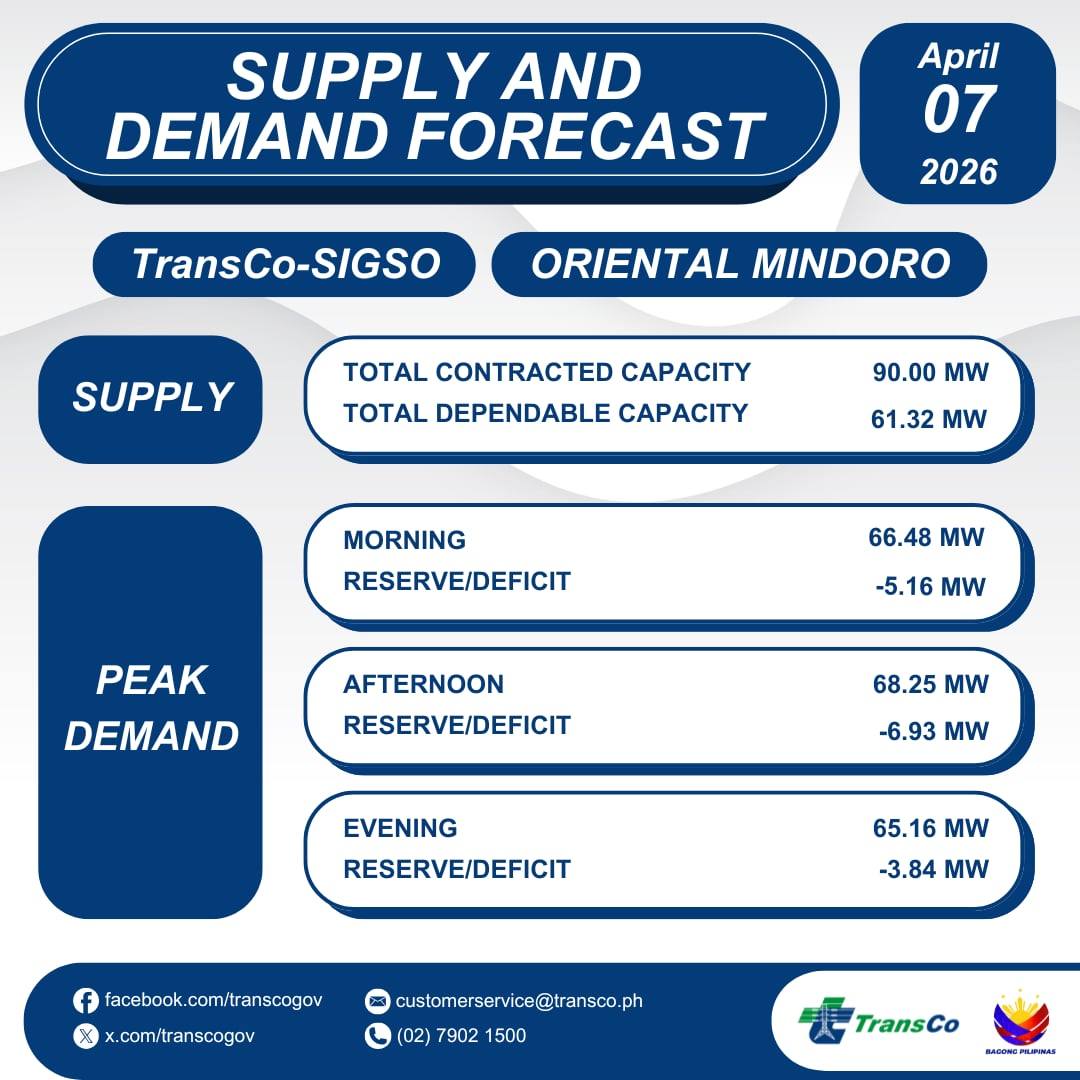

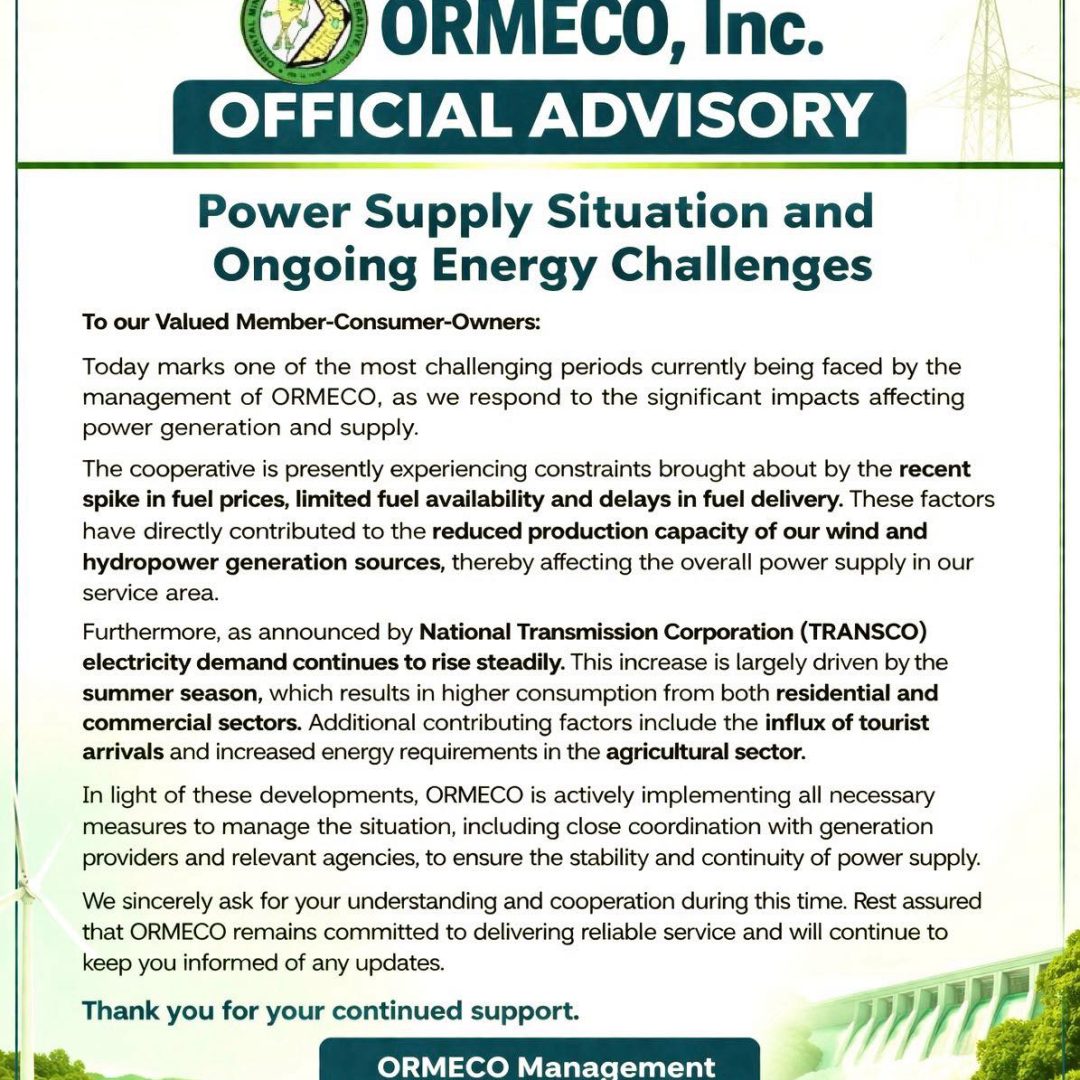

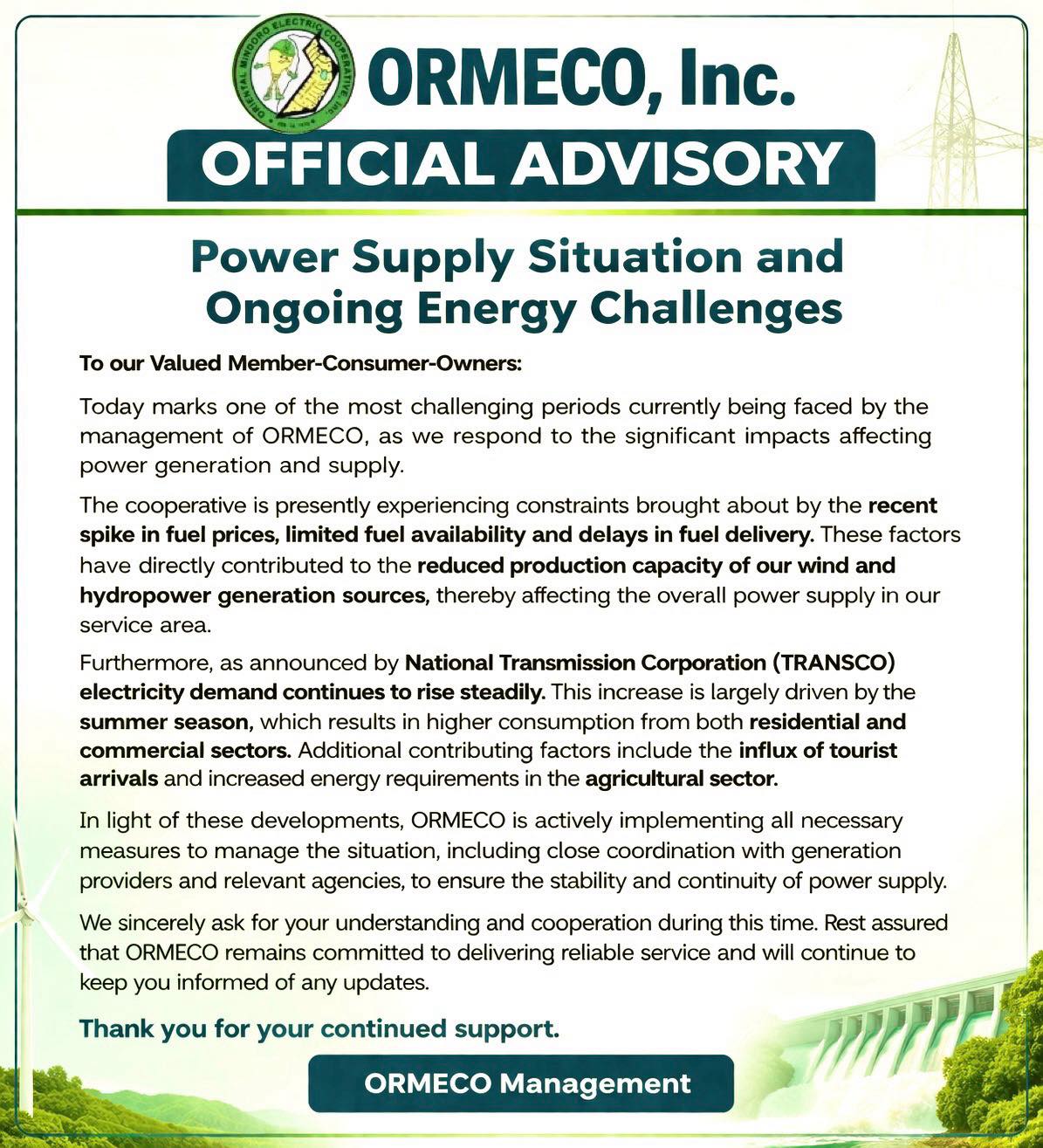

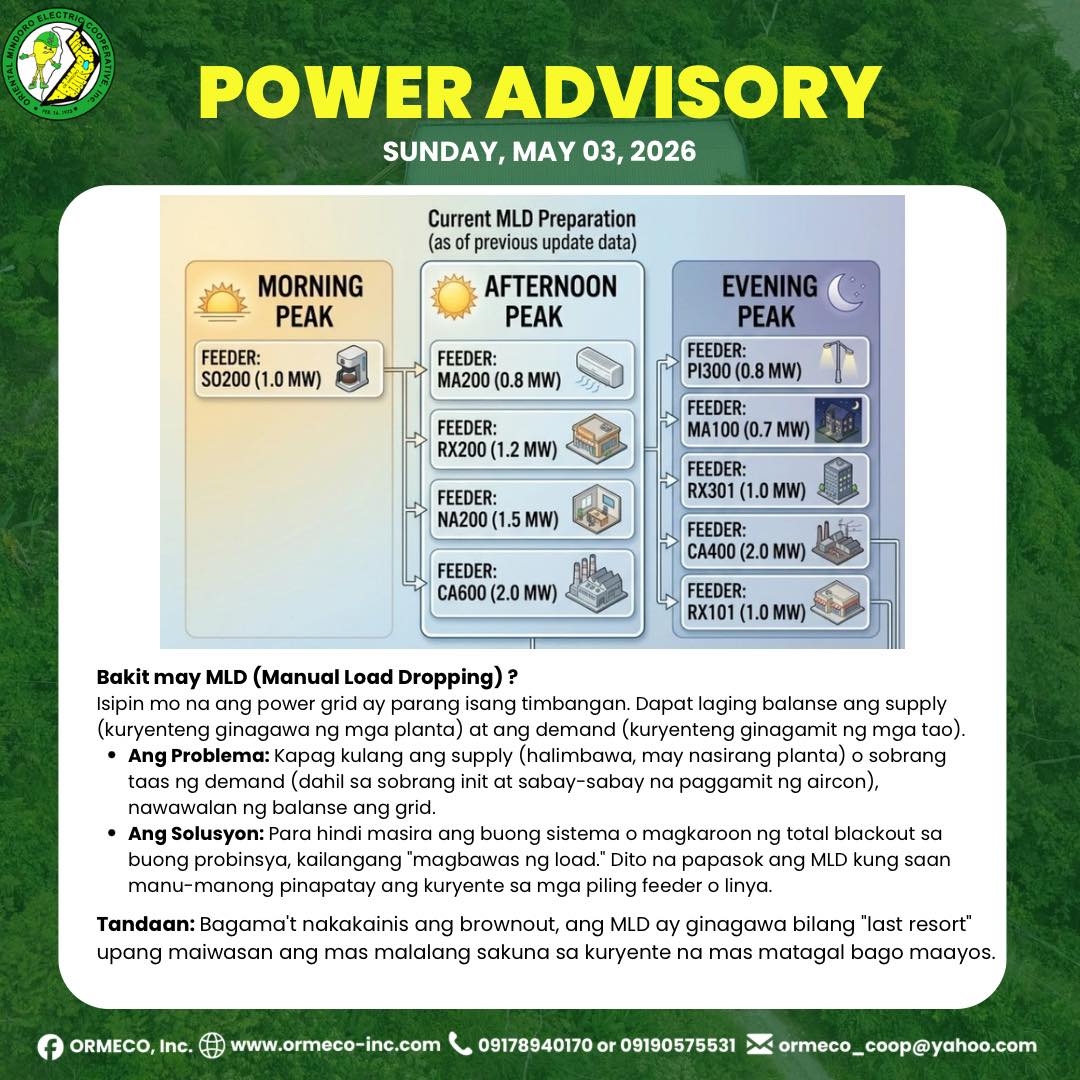

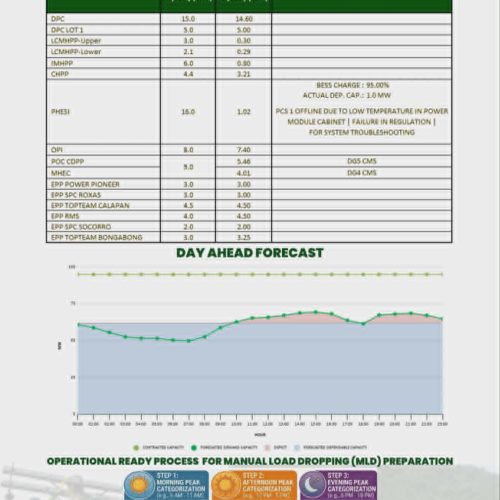

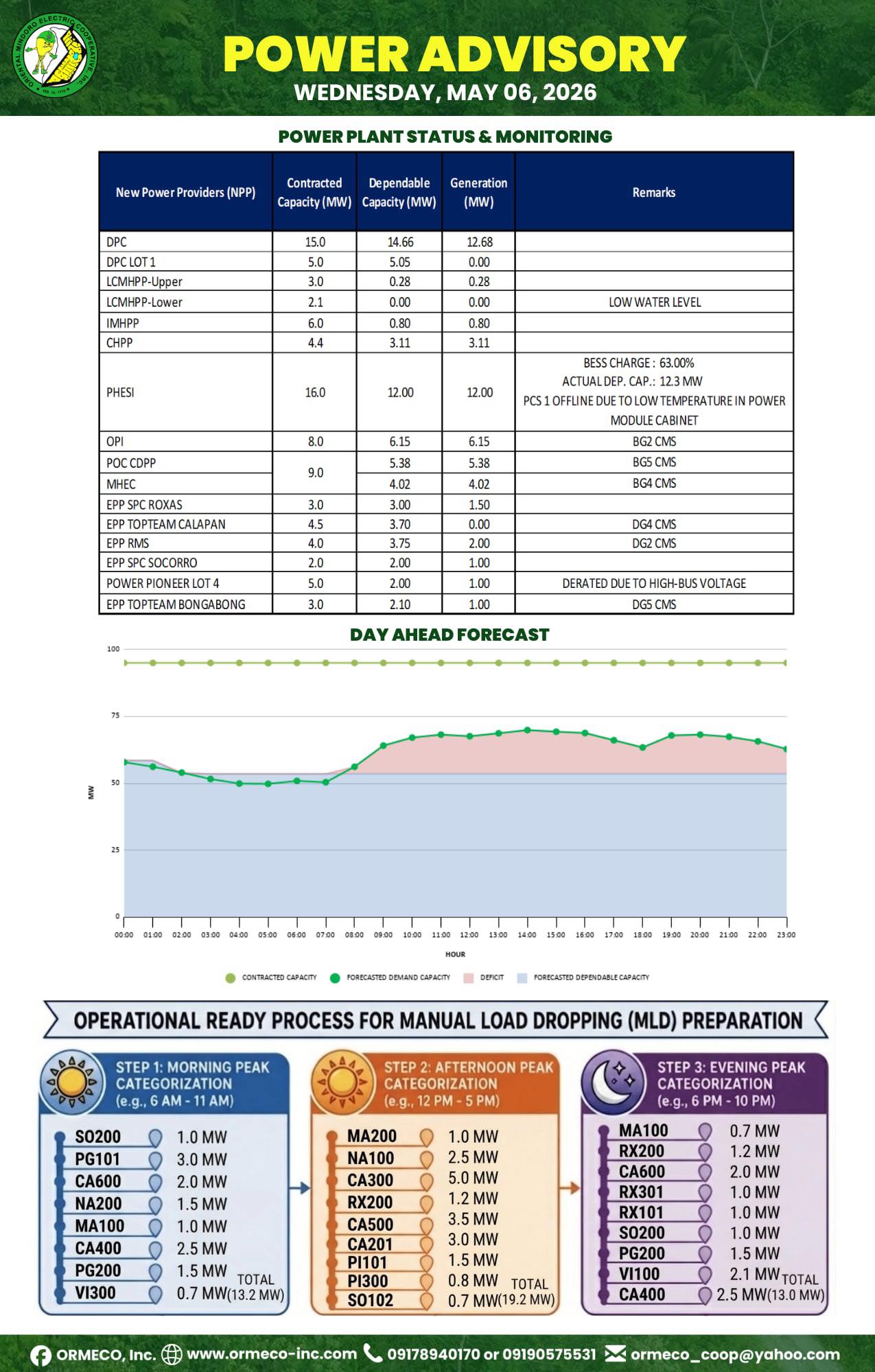

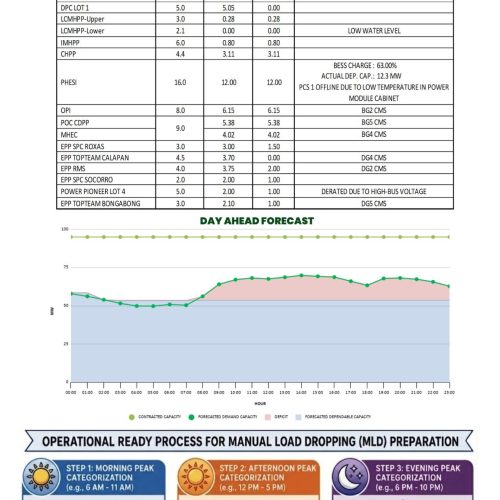

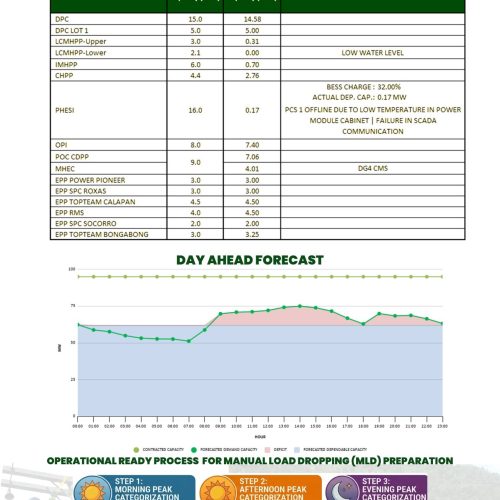

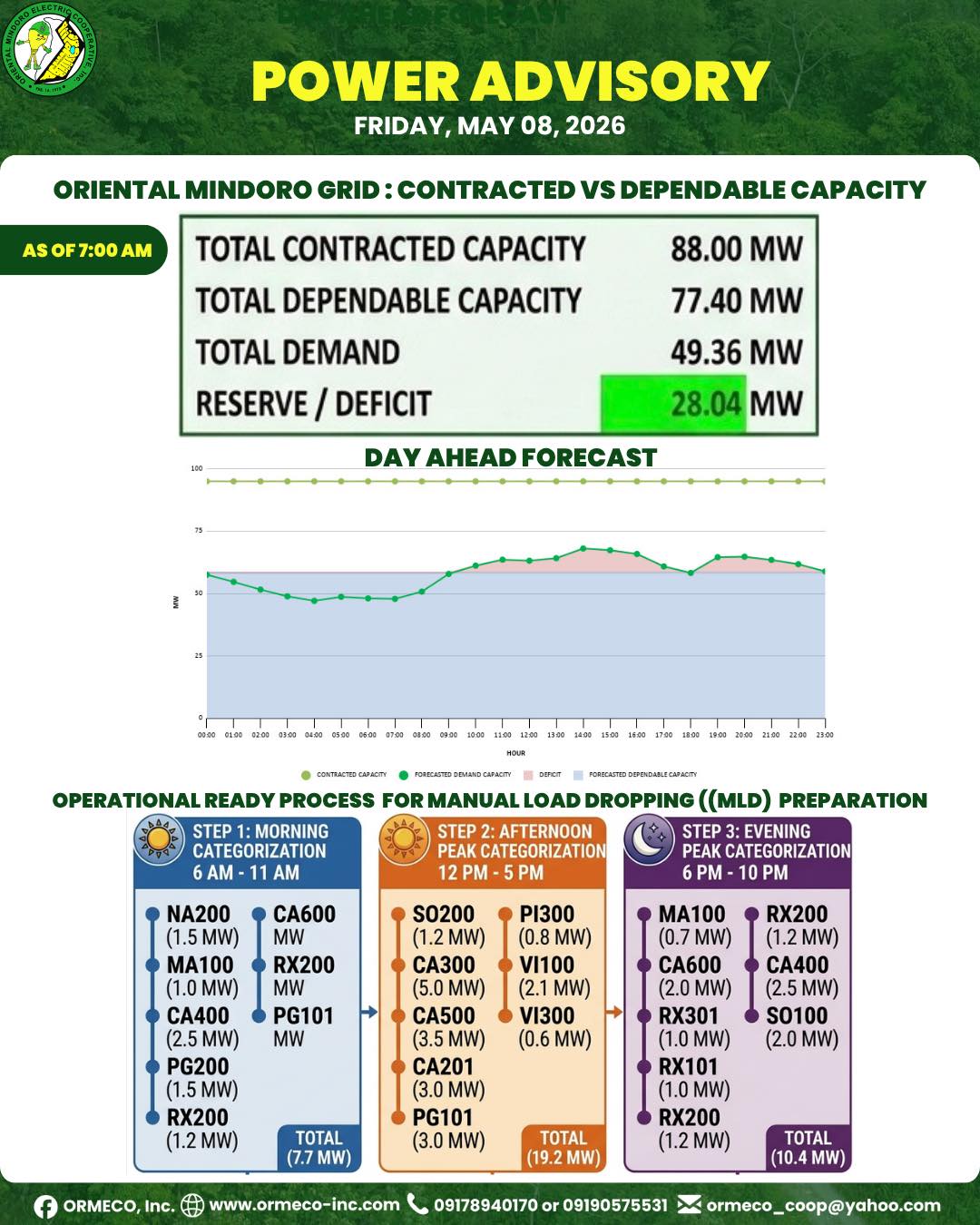

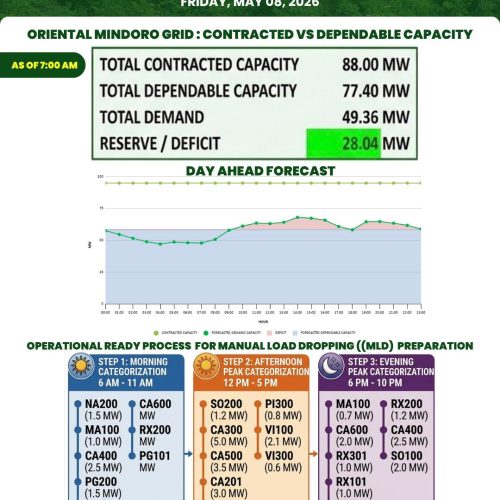

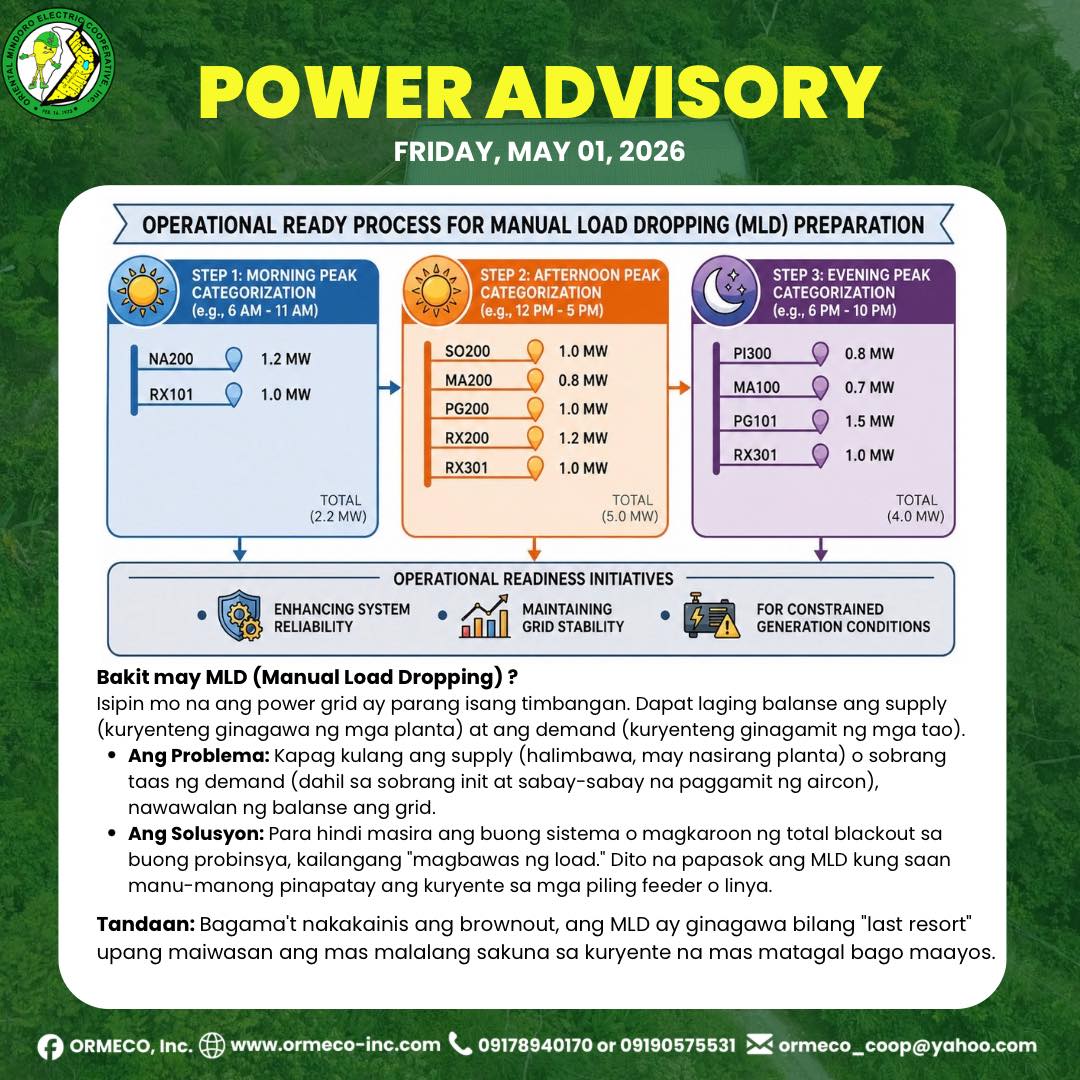

⚠️ 𝐌𝐀𝐍𝐔𝐀𝐋 𝐋𝐎𝐀𝐃 𝐃𝐑𝐎𝐏 (𝐌𝐋𝐃) 𝐒𝐓𝐀𝐓𝐔𝐒 𝐑𝐄𝐏𝐎𝐑𝐓 🗓️ June 16, 2026 (as of 1:59 PM) 📌 MGA FEEDER NA POSSIBLENG MAG-MANUAL LOAD DROPPING: SO102 PI300 SO200 BS100 VI300 NA100 CA300 CA201 CA501 CA500 NA200 LBS PINAMALAYAN CA400 📌 MGA FEEDER NA KASALUKUYANG WALANG KURYENTE ALL FEEDERS ARE ENERGIZED 📌 MGA FEEDER NA MULING NAIBALIK ANG KURYENTE VI300 - 1:43 PM CA600 - 1:58 PM 🏠👉For feeder coverage please click: https://www.facebook.com/share/p/1cMFsk7rm7/ 💡 Patuloy pong nagsasagawa ang ORMECO ng operational readiness measures upang mapanatiling matatag ang suplay ng kuryente sa buong Oriental Mindoro habang may kakulangan sa available generation capacity mula sa ilang power plant. 💡 Ang pansamantalang pag-open ng ilang feeder ay ginagawa upang maiwasan ang mas malawak na pagkawala ng kuryente at maprotektahan ang buong power system ng isla. 🔋 𝐏𝐋𝐀𝐍𝐓 𝐒𝐓𝐀𝐓𝐔𝐒 • Bawas sa kabuuang produksyon ng kuryente mula sa mga renewable energy sources • GFEC Roxas (8.0 MW Contracted Capacity) - 5.50 MW dependable capacity - Limitasyon sa Linya (Line Constraints) • EPP Topteam Calapan (4.5 MW Contracted capacity) - 3.0 MW dependable capacity - Ang DG2 at DG7 (1.5 MW) ay sumasailalim sa CMS (Kasalukuyang Kinukumpuni) • EPP Topteam Bongabong (3.0 MW Contracted capacity) - 2.75 MW dependable capacity - Limitasyon sa Boltahe (Voltage Constraints) • DMCI Calapan BG3 (3.75) - Sumasailalim sa CMS (Kasalukuyang Kinukumpuni) ⚡ Ang mga nabanggit na kondisyon ay nagreresulta sa pagbawas ng available generation capacity sa grid, kaya kinakailangang magsagawa ng mga load management measures upang mapanatili ang katatagan ng power system sa Oriental Mindoro. 🙏 Maraming salamat po sa inyong pang-unawa at pakikiisa. 💚⚡
